 Wonder if we could install 1 of those . . . 3/08
|  Let's put the Wind Turbine where Shaar is hiding behind that 2x4
5/26/08

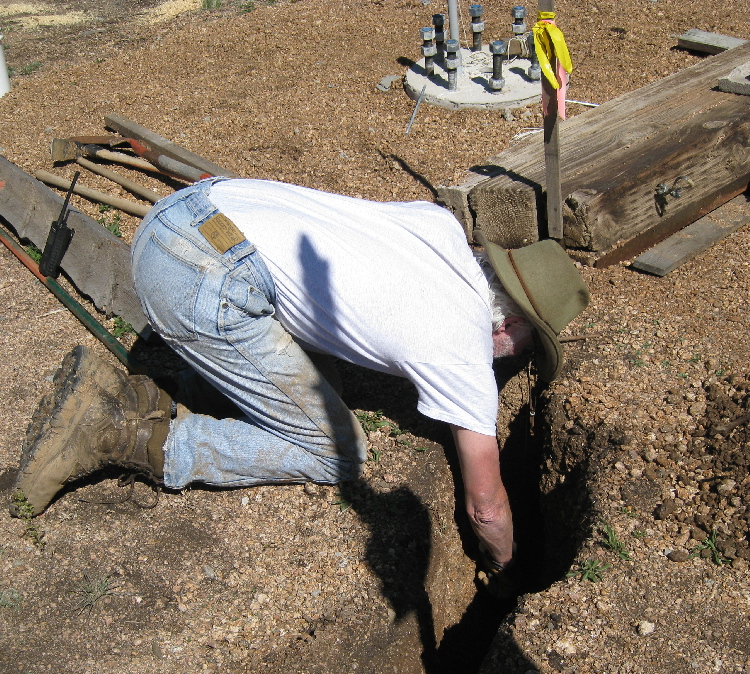

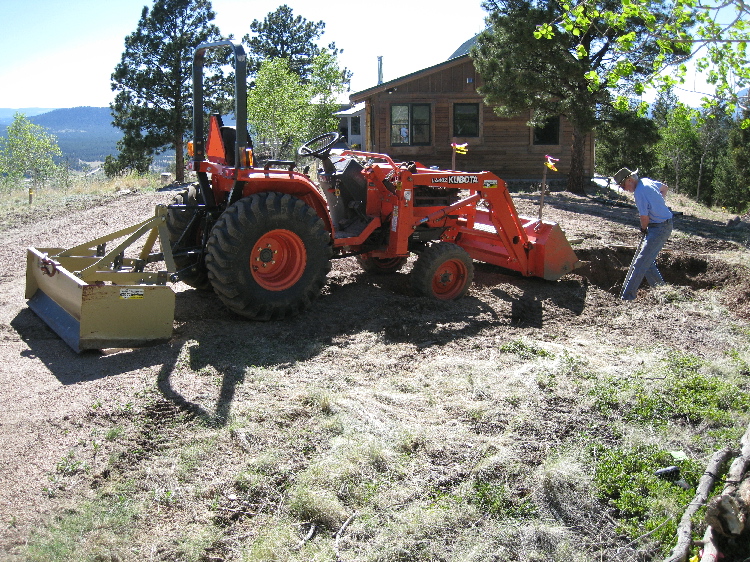

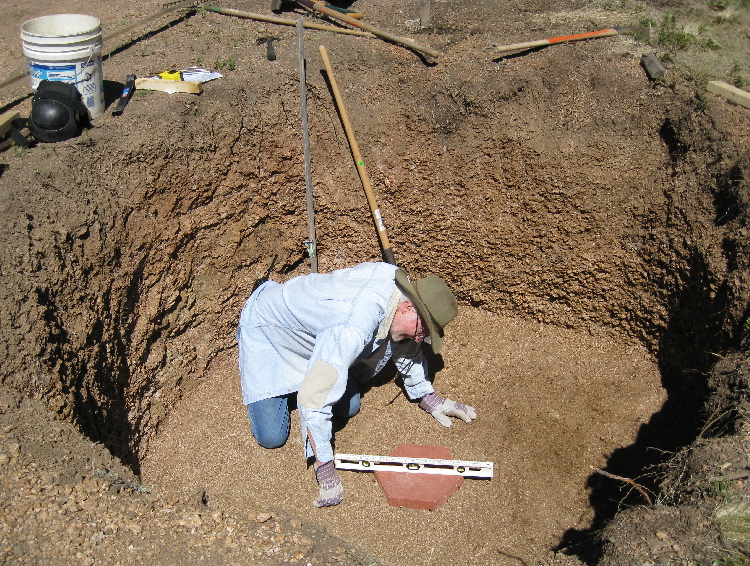

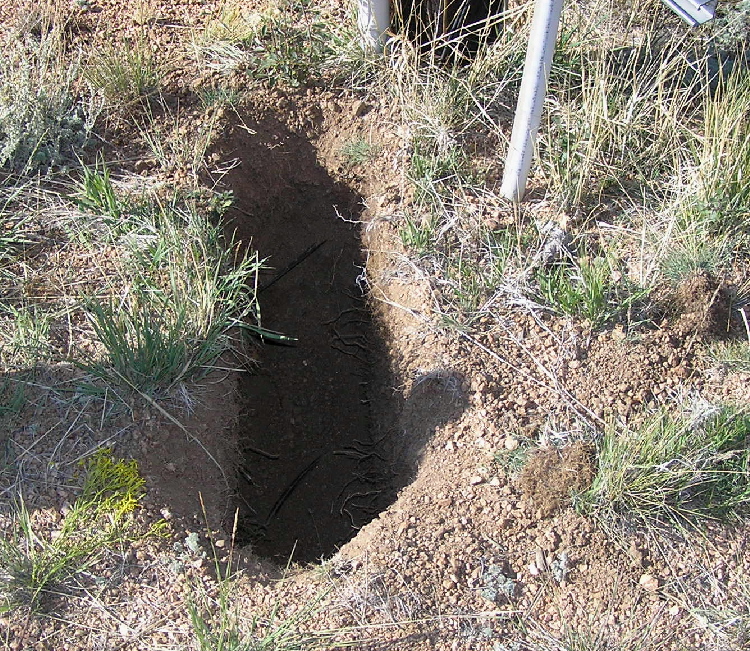

|  Neil starts a test hole for the foundation 6/6/08
|

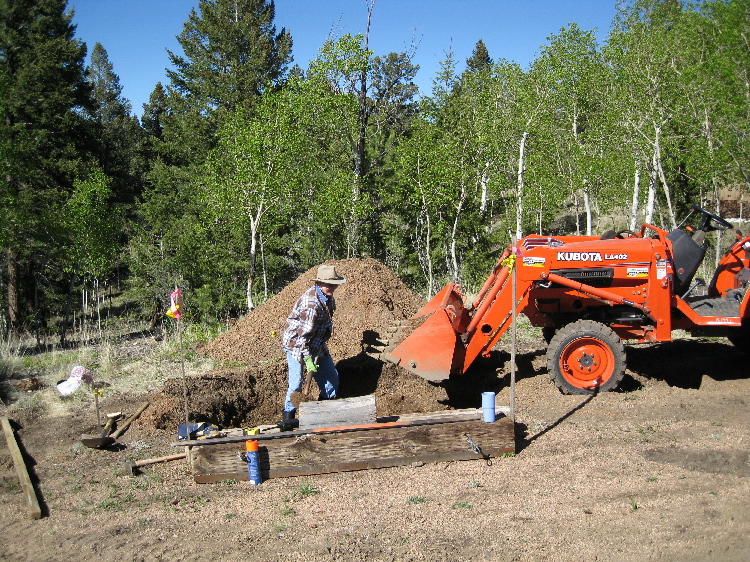

 Michal takes a turn at the shovel 6/6/08
| PLANS FALLING INTO PLACE SO WE APPLY FOR BUILDING PERMIT 6/13/08 (FRIDAY)!

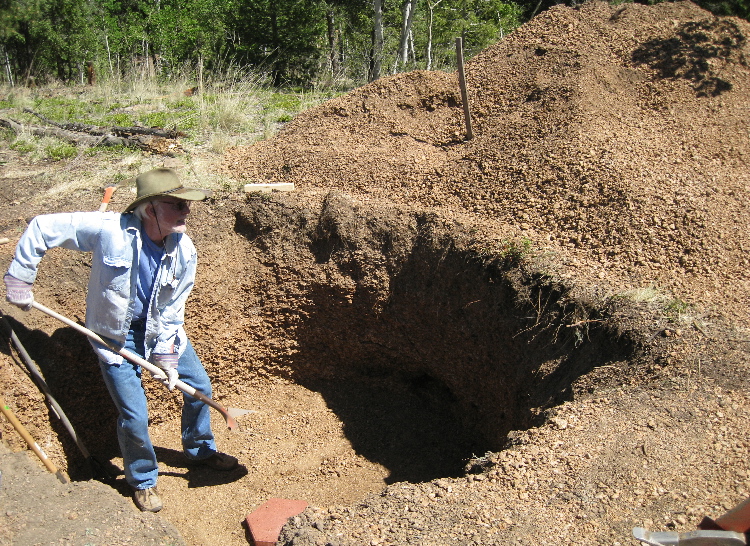

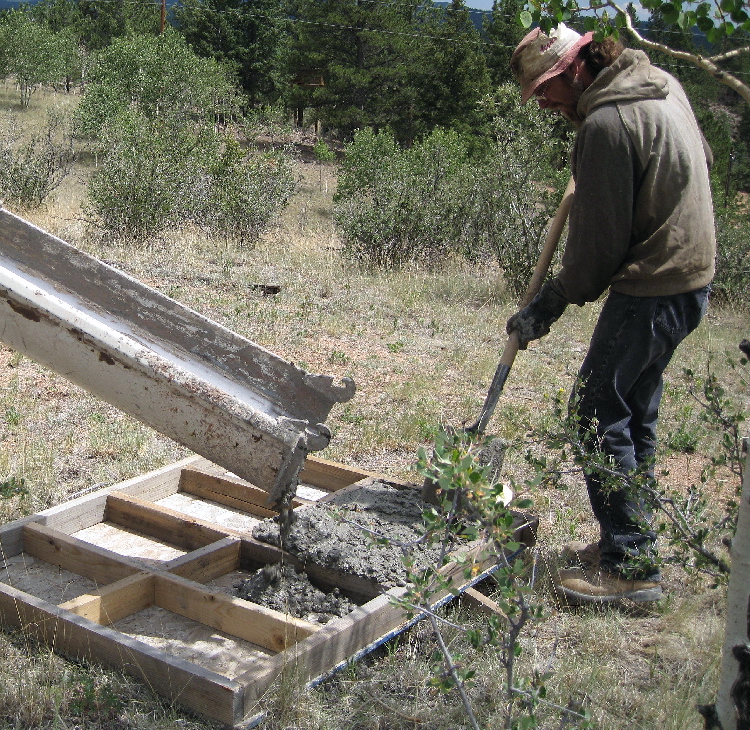

|  The (almost) last shovel full leaves the foundation excavation 6/14/08
|
 Leveling the base for the foundation structure 6/14/08 ("Test hole" until we get the building permit)

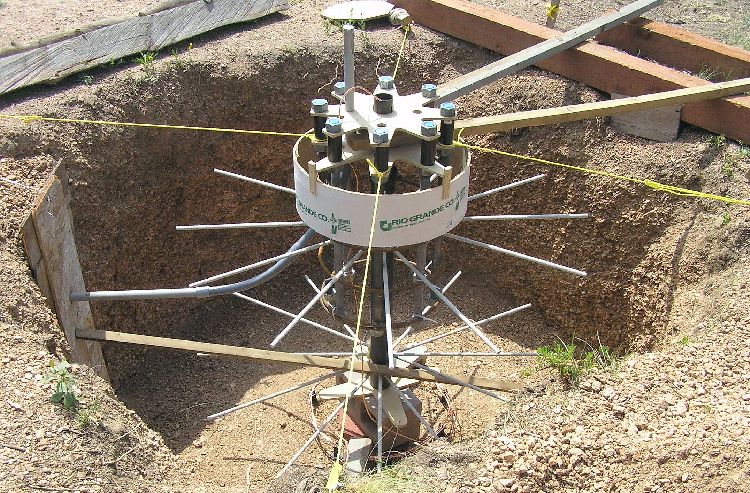

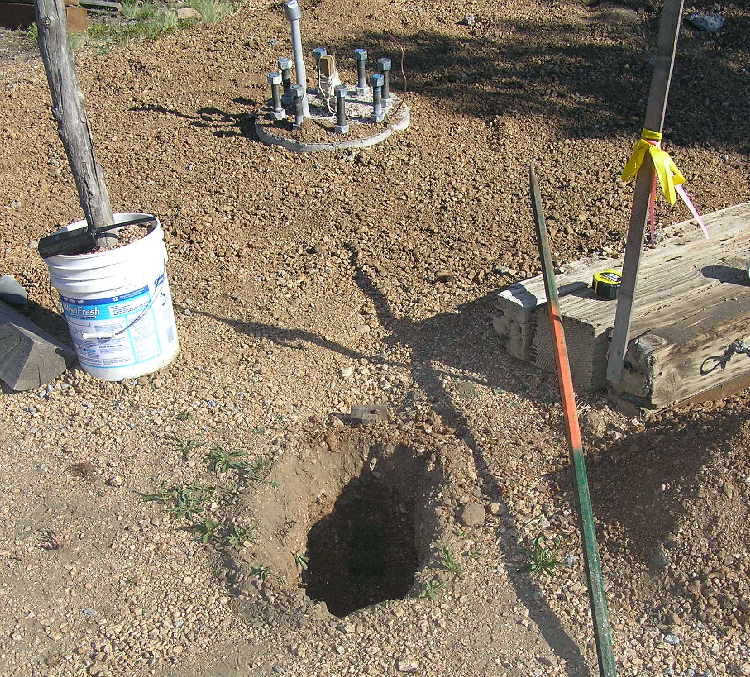

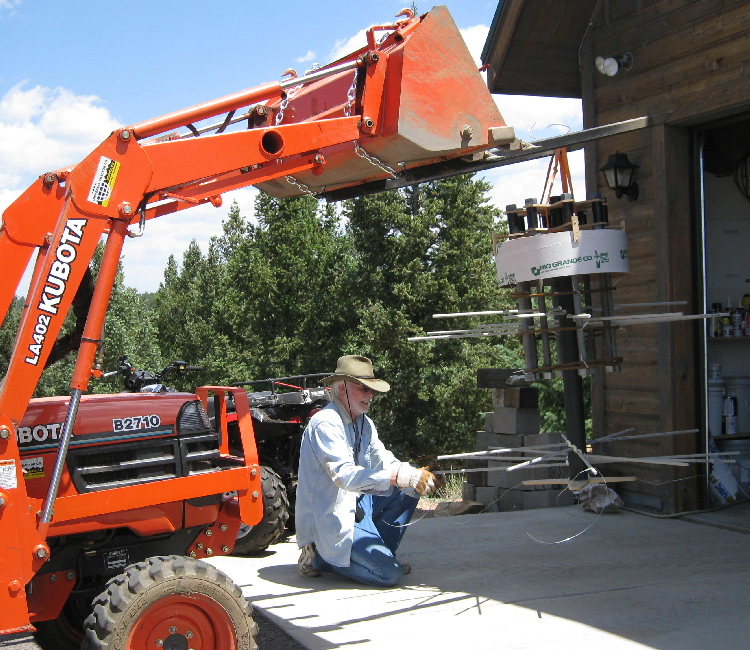

|  7/8/08 Building permit issued. 7/9/08 start on SMarT foundation

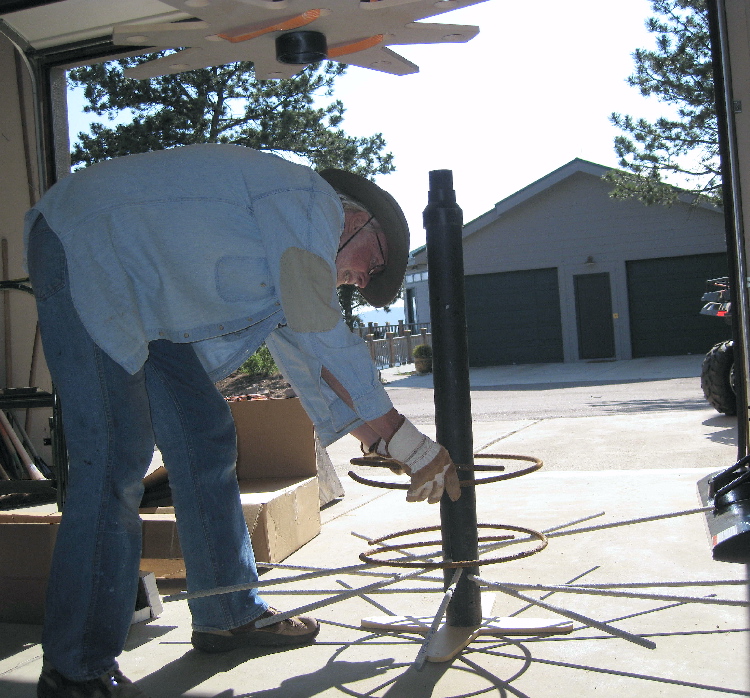

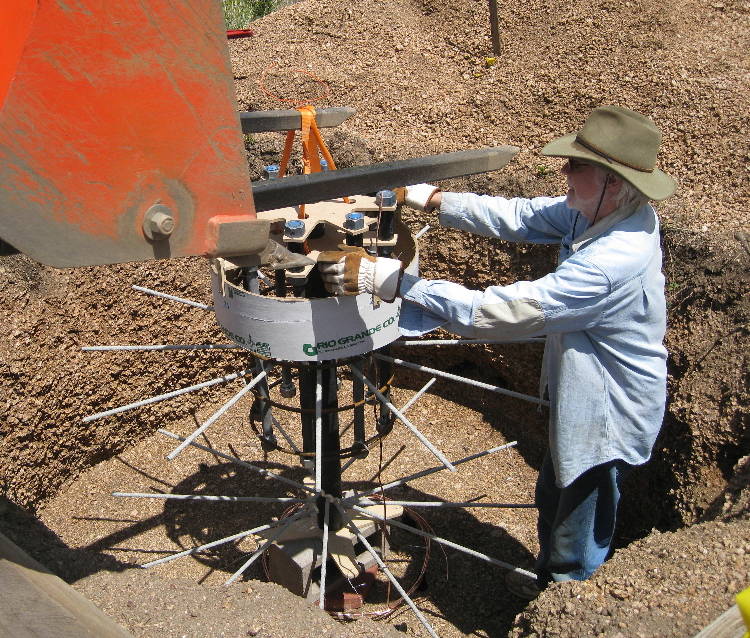

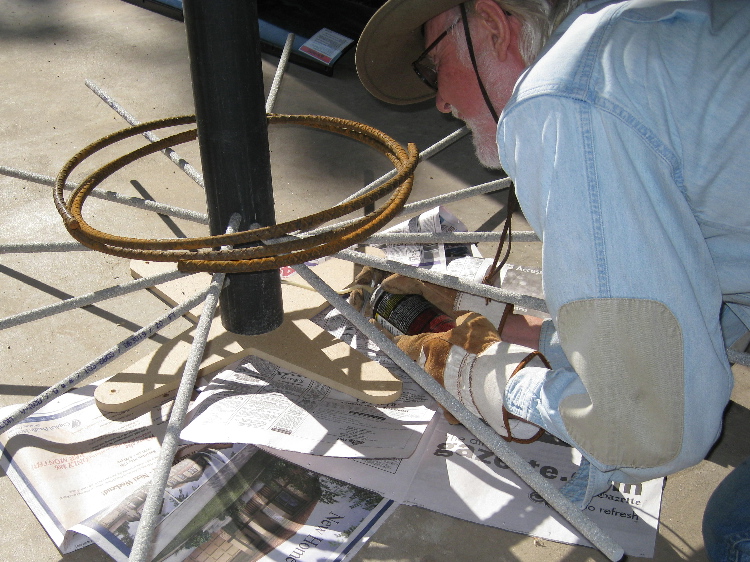

|  Inserting FRP re-bar in lower stanchion (FRP is Fiber Reinforced Polymer)
|
 Placing steel rebar over stanchion, resting on FRP
|  Placing FRP rebar on upper stanchion
|  Injecting expanding foam to secure FRP rebar
|
 Assembly suspended from ceiling
so can place anchor bolts and

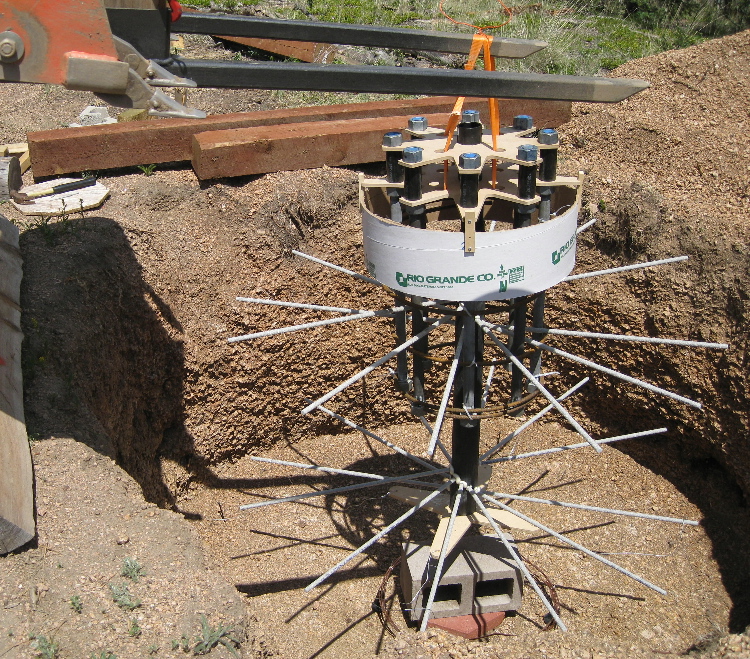

template over rebar stanchion. Upper steel rebar in place

|  Copper grounding coil in place 2-1/2" above base of Concrete
7/10/08

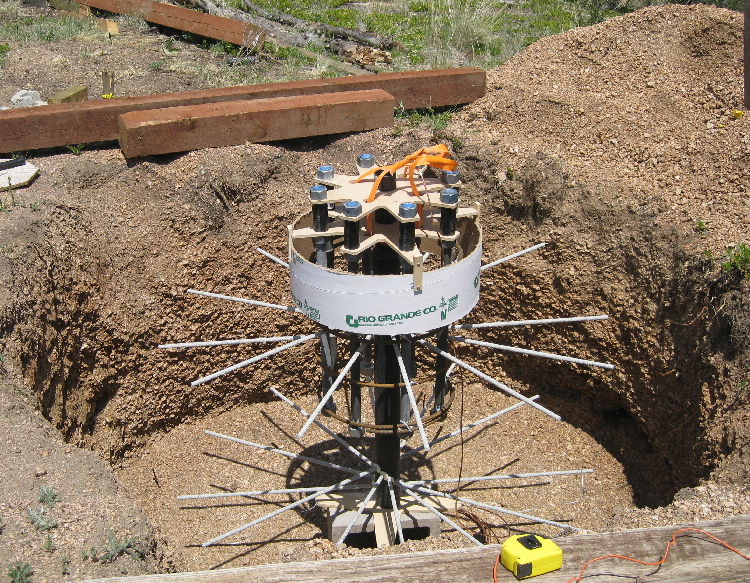

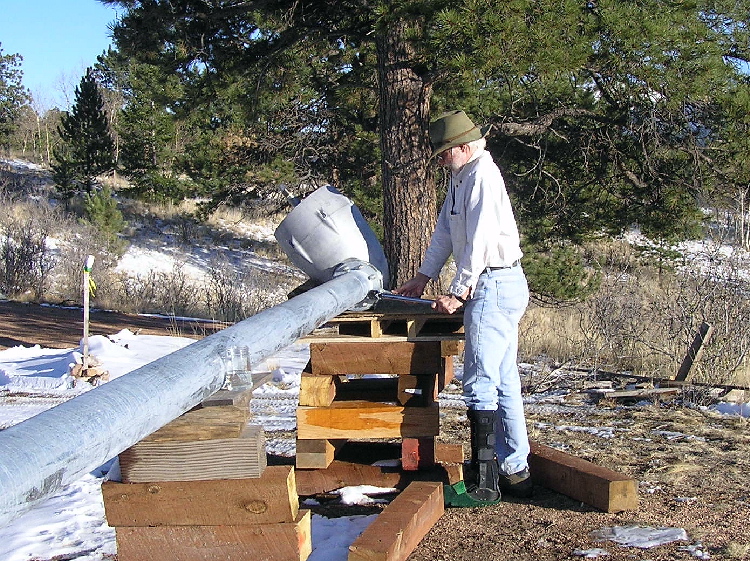

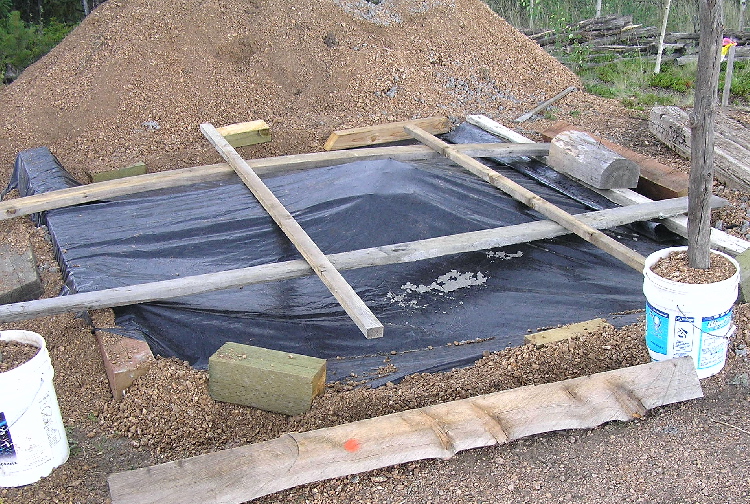

|  Sonotube attached. Rebar rings secured to anchor bolts. Securing wires to steady base.
|
 Transporting to excavation
|
 Lowering into place
|
 Final check before last 2" down
|
 Re-siting on foundation blocks

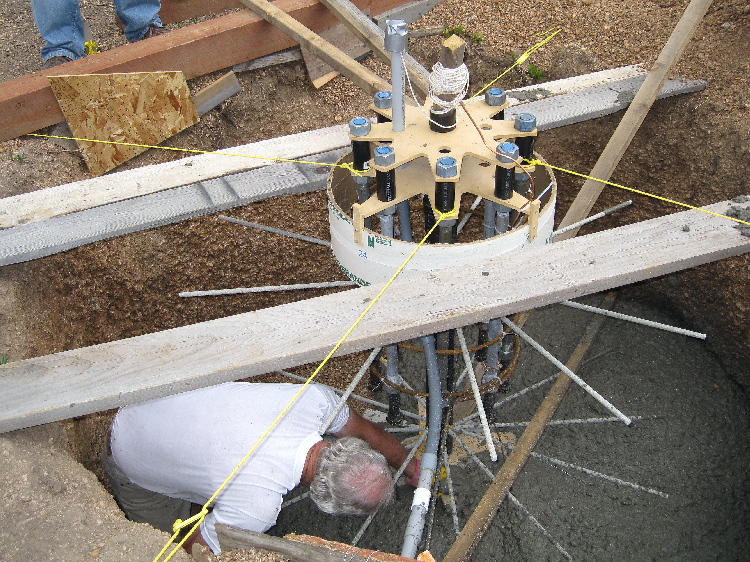

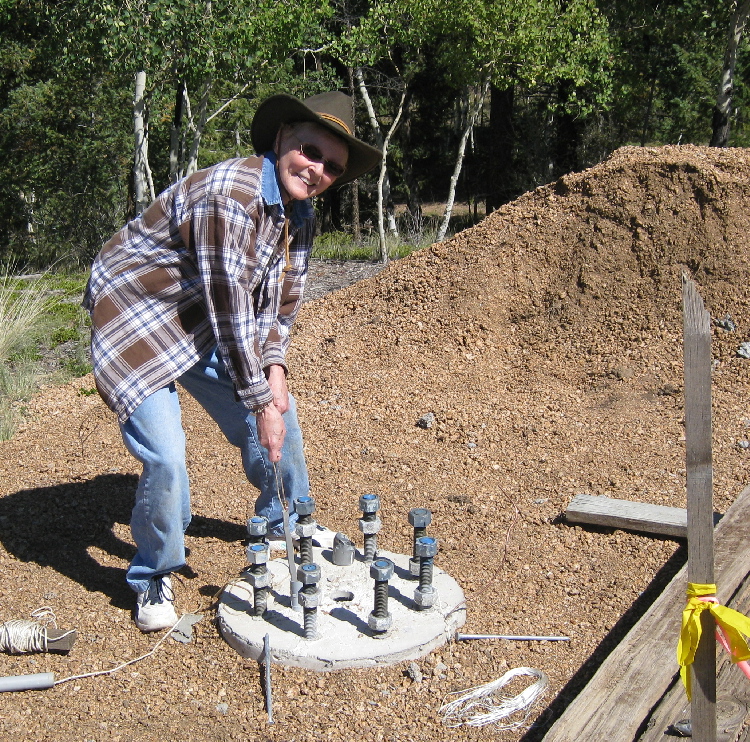

|  7/12/08 Alligned, leveled, secured, electrical conduit in place, ready for inspection and concrete pour

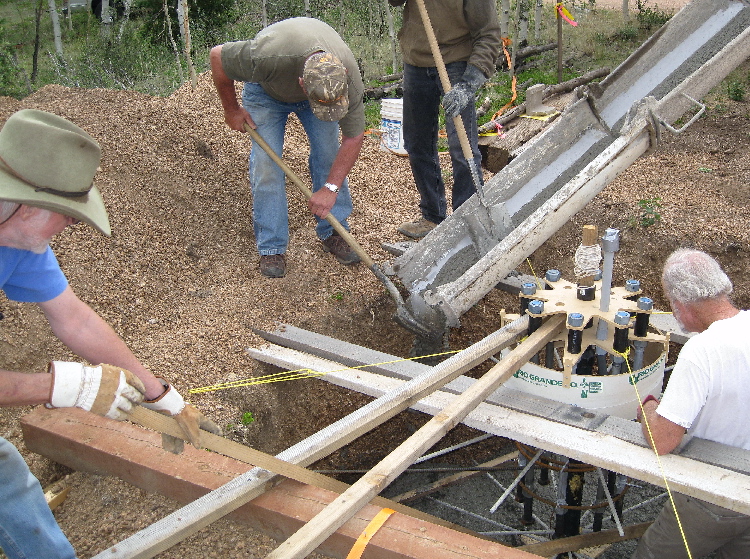

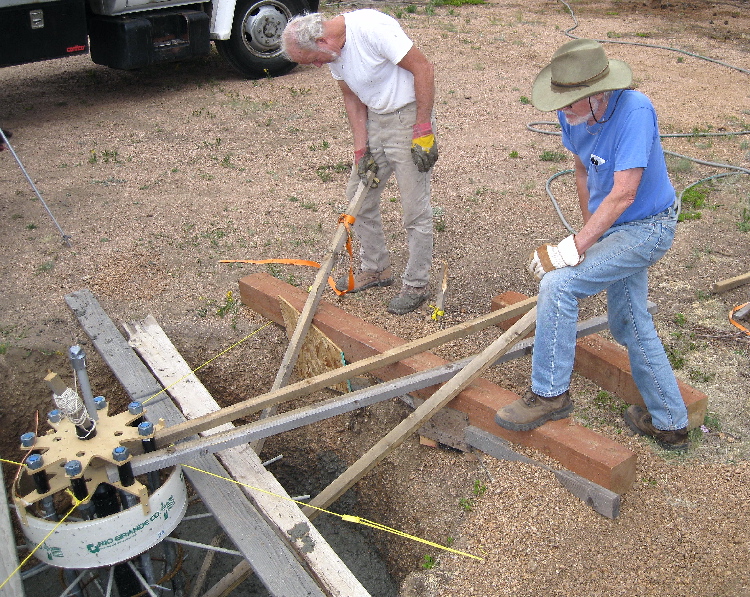

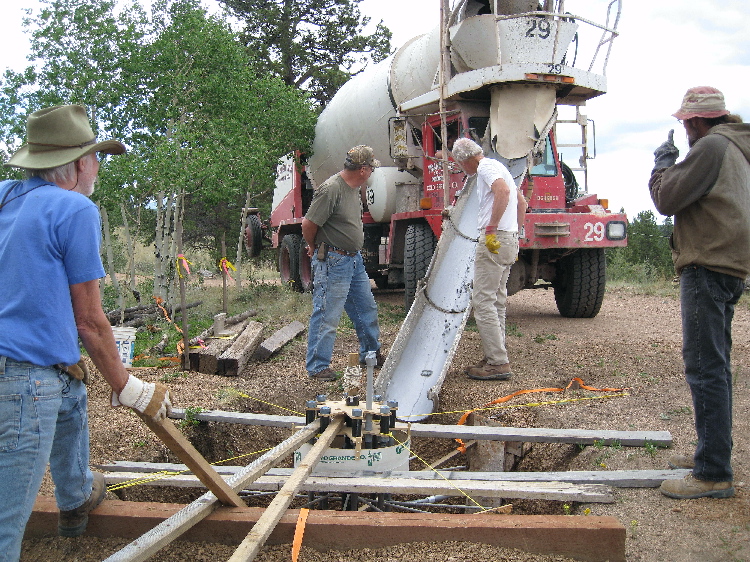

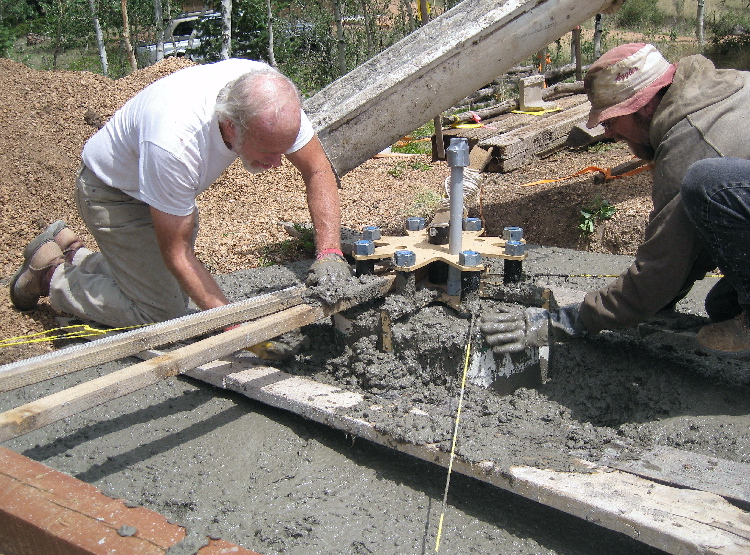

|  Neil, Gerald, Gene & Aaron ready for the first mud 7/22/08
|
 Neil braces, Gene gets into his work, Gerald controls flow

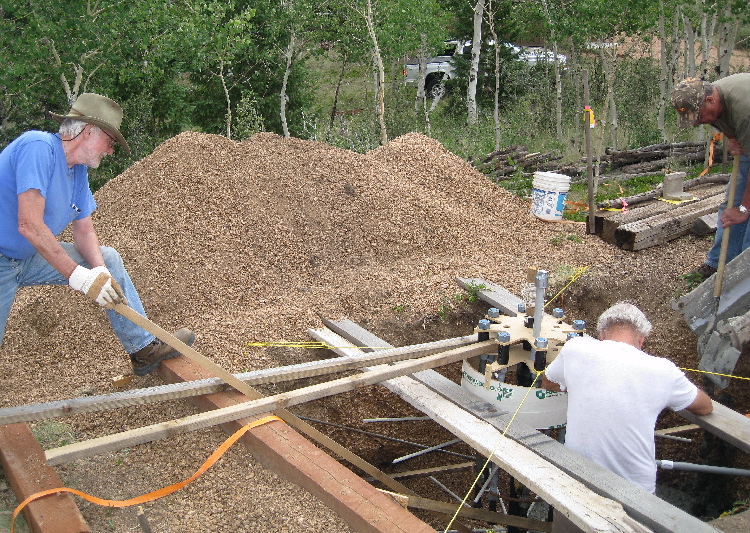

|  About to cover base

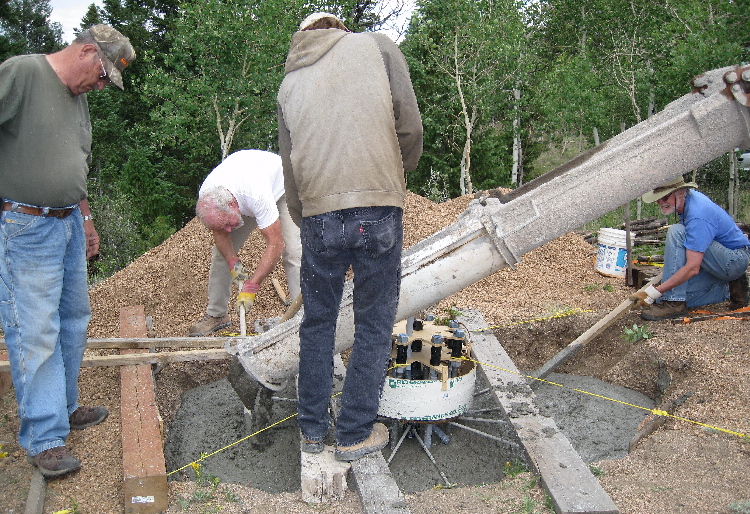

|  Gene makes sure base is filled solid
|
 About half full
|
 Insuring Mud reaches all nooks and crannies
|  Hand work to fill the raised center column
|
 Aaron makes stepping stones with the extra mud
|
 Let it cure for a few weeks
|  9/2/08-Home from vacation Foundation cured and ready for
tower
|

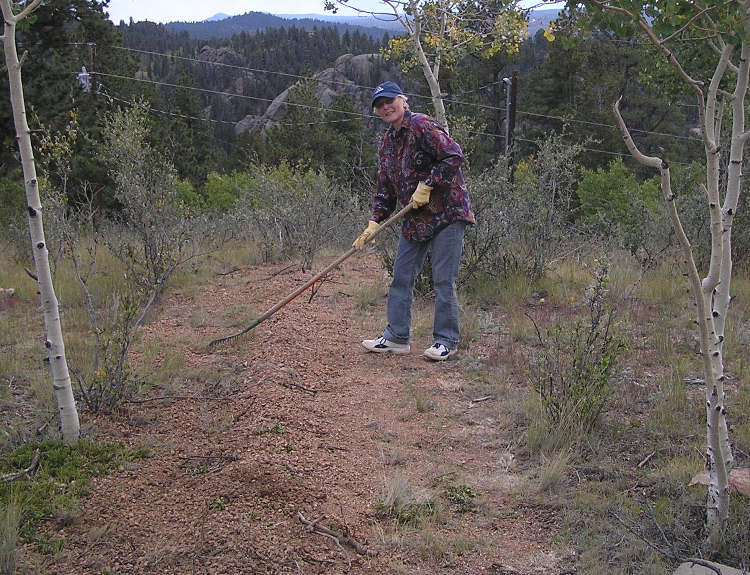

 Hand dug trench-top 9/9/08

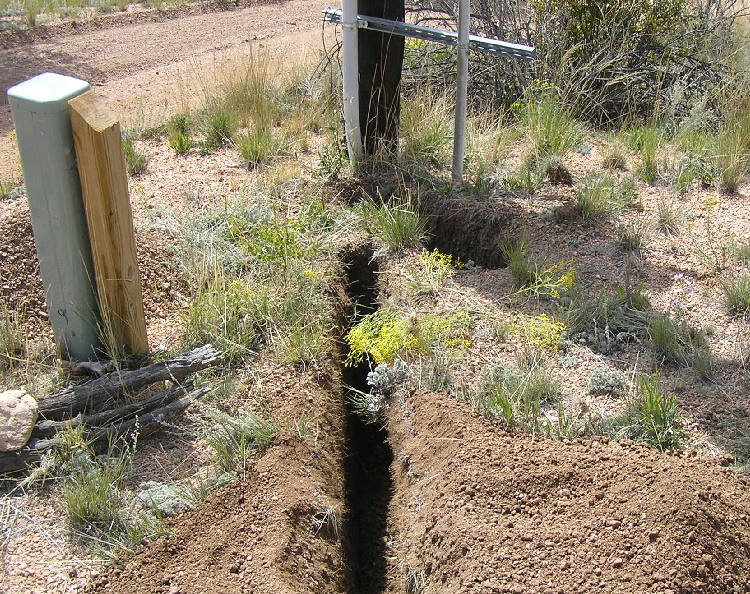

|  Hand dug meter end

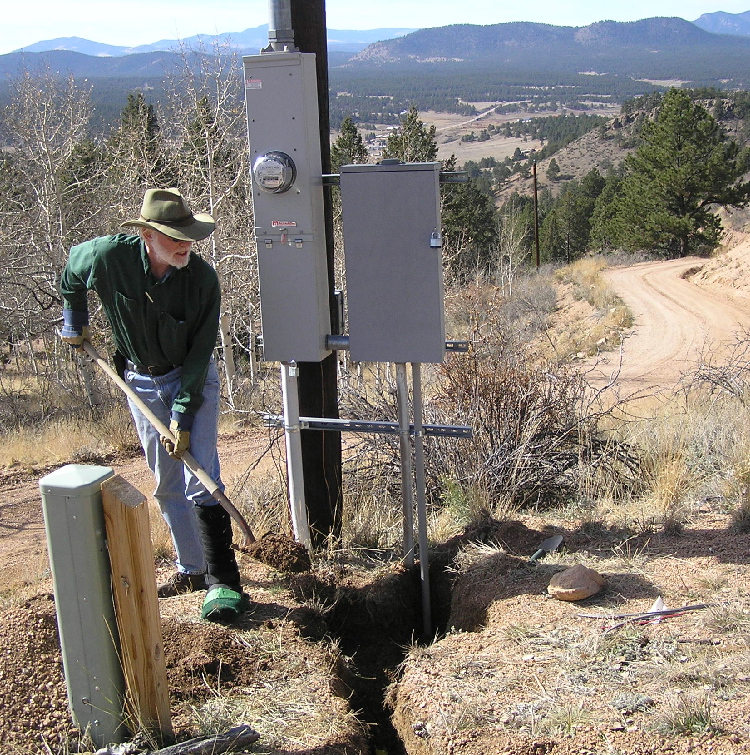

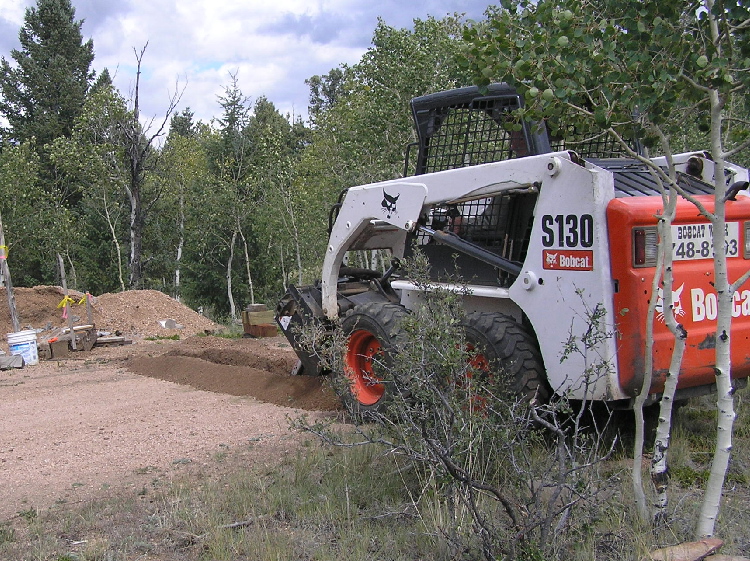

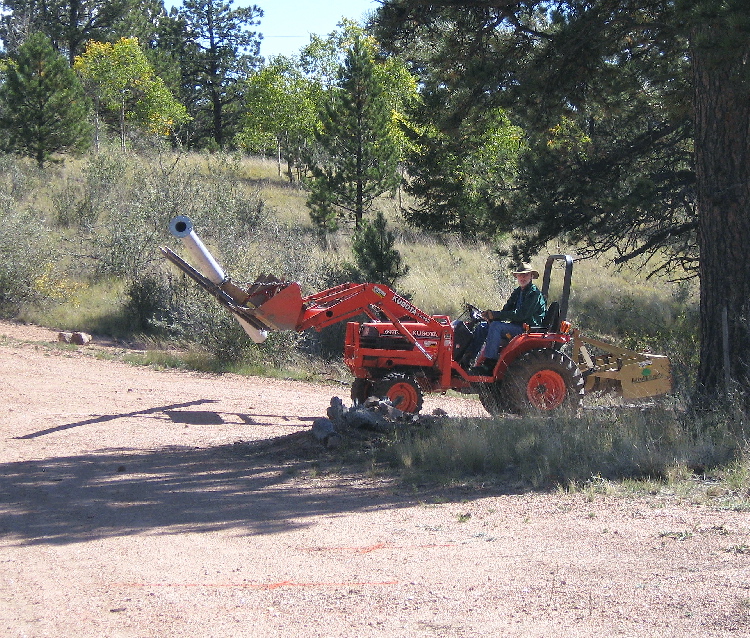

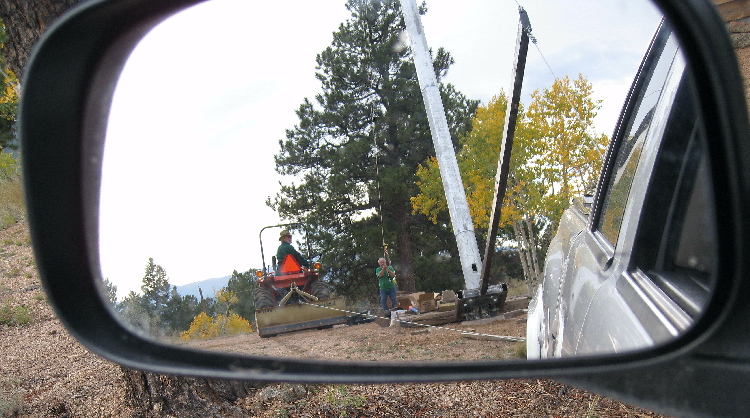

|  Mike starts Bobcat trench
9/11/08
|

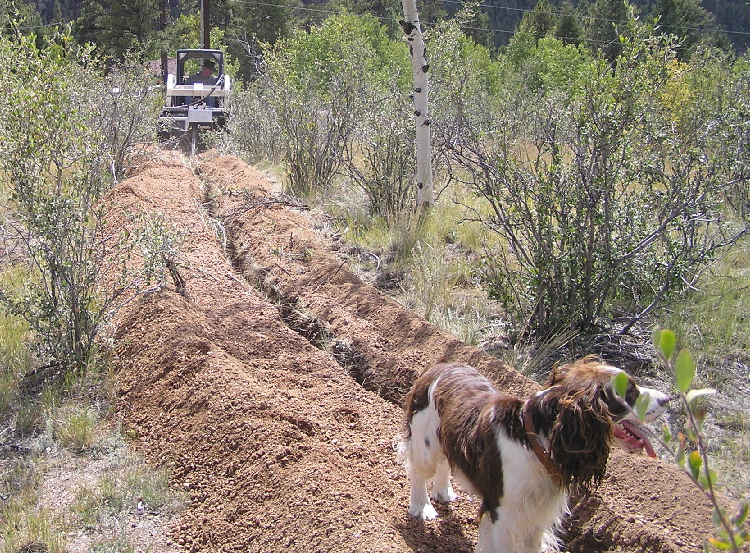

 Mike trenches - one of his 3 dogs inspects
|  Trench end - meter pole

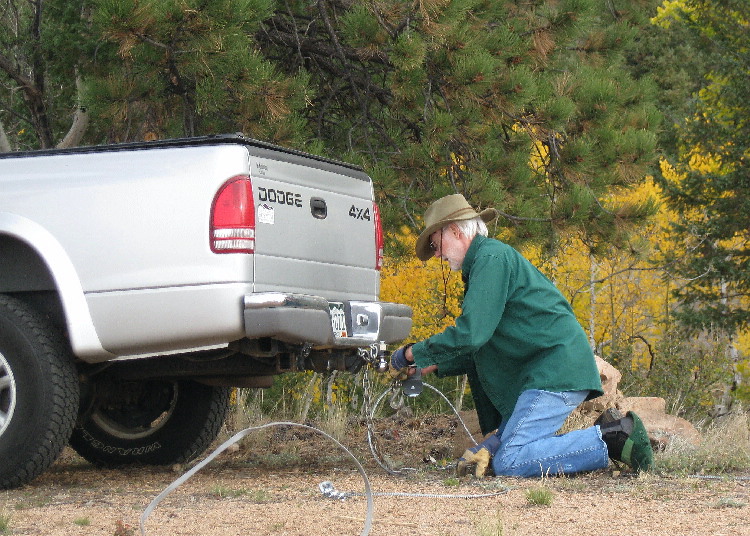

|  Where-da-heck is the end of that conduit? 9/13/08
|

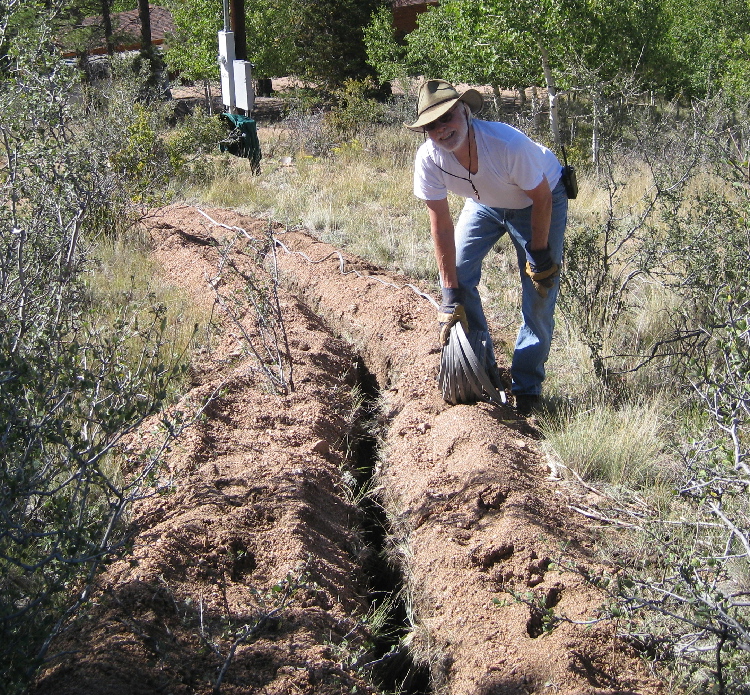

 Unrolling cable 9/15/08
|  Success! Cable thru conduit in foundation
|  Trench filled in - Michal adds final touch 9/20/08
|

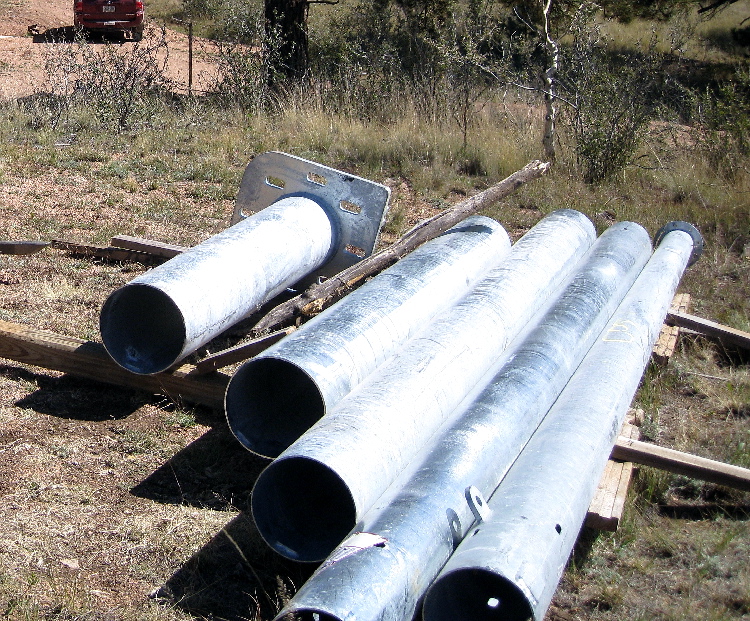

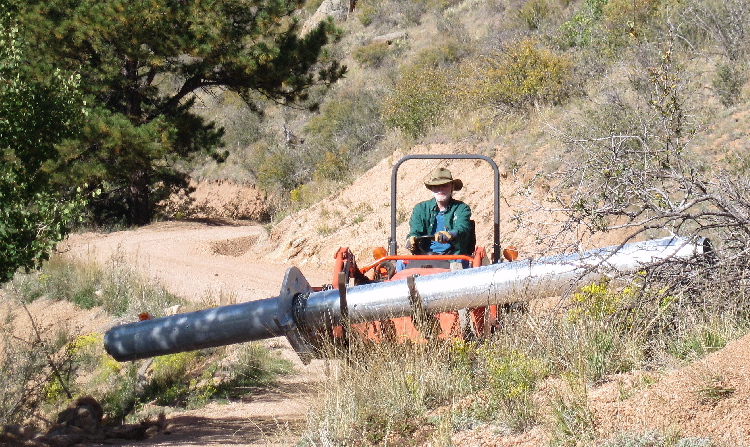

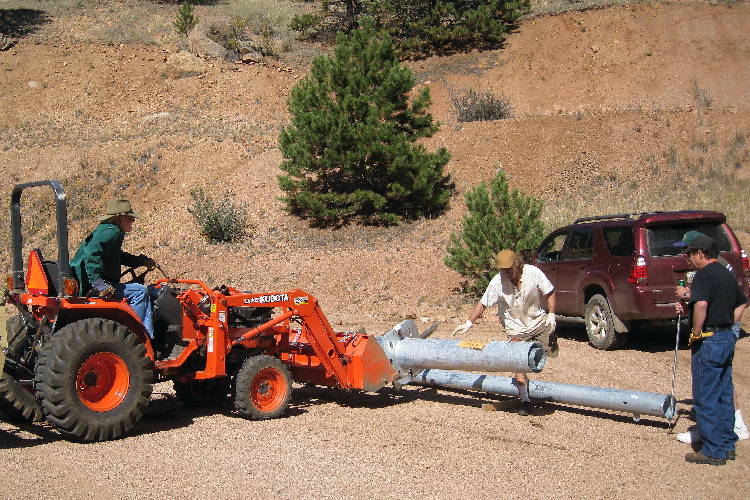

 Nested Tec-Wind tower sections

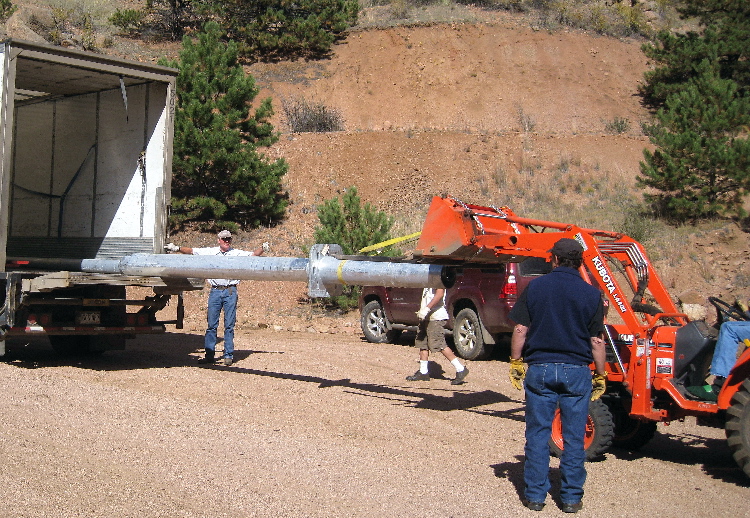

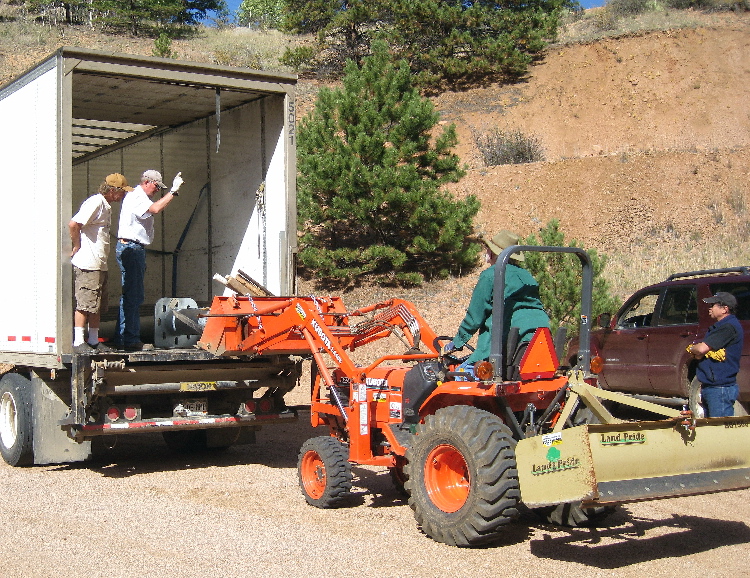

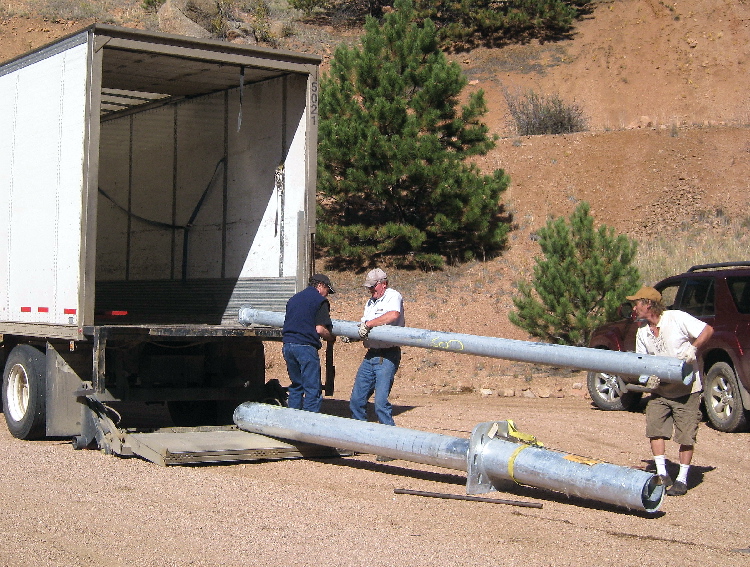

ready to be unloaded. William, Glen (truck driver), John FVFR Vol - all helping 9/22/08
|  Off come the tower sections
|  Separate top section unloaded the old fashioned way
|

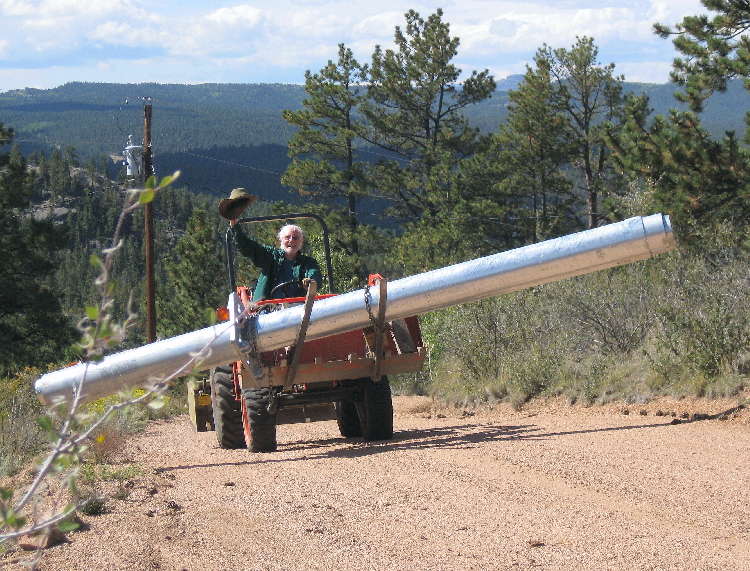

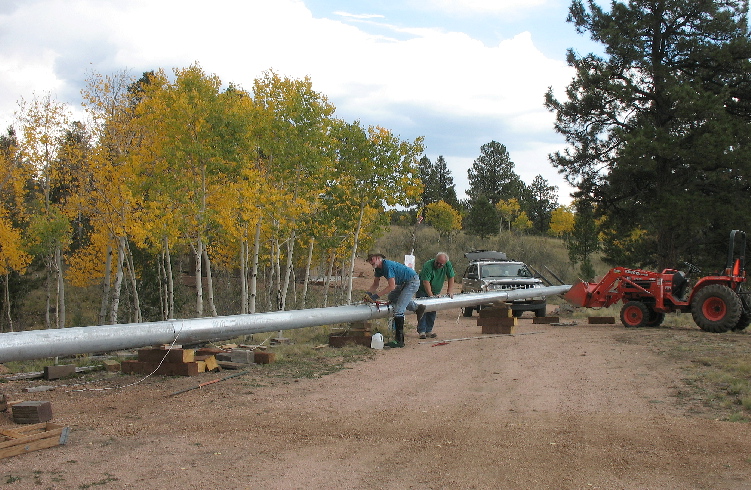

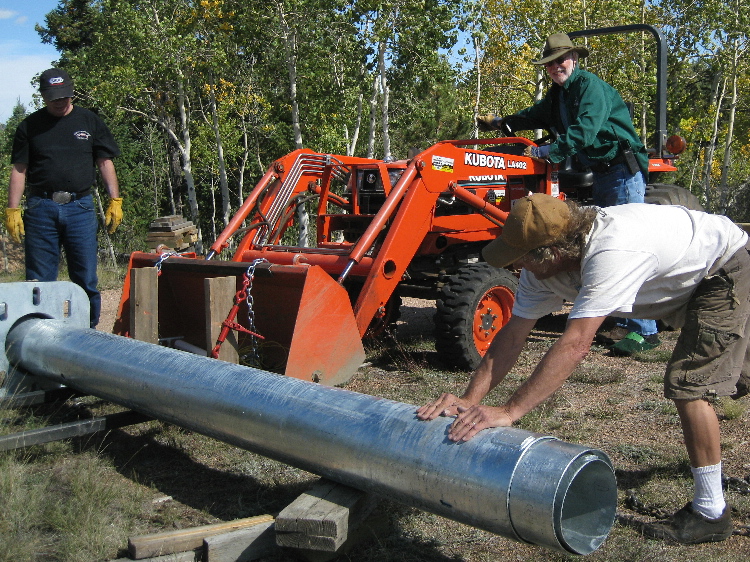

 Loading heavy nested tower sections for the run uphill

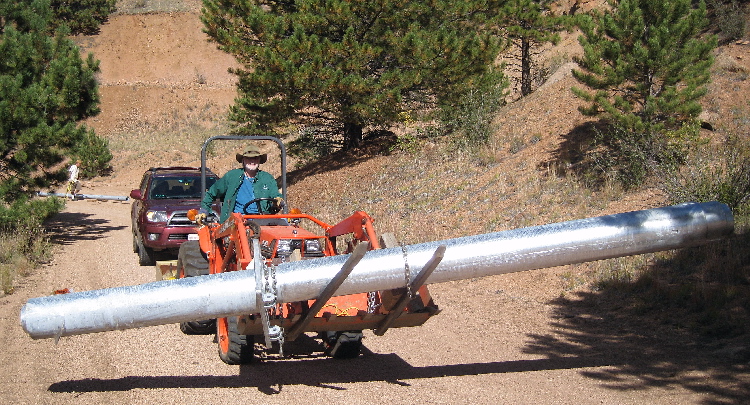

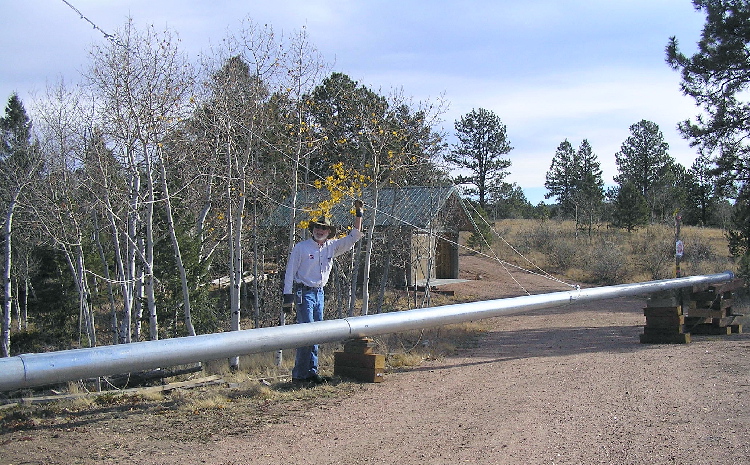

|  Starting up the driveway
|  3/4 mile later all sections still on!
|

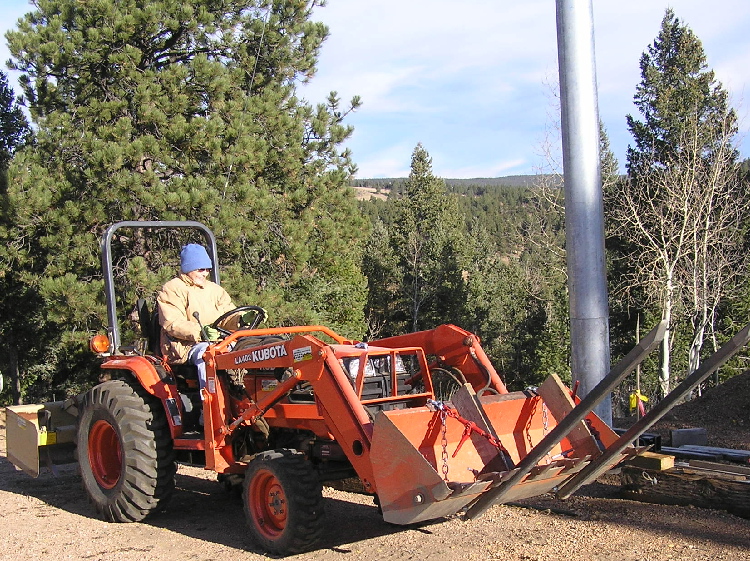

 Almost to top . . .
|  Nested sections parked
|  Top section almost there
|
 Sections un-nested & ready
for de-burring and assembly

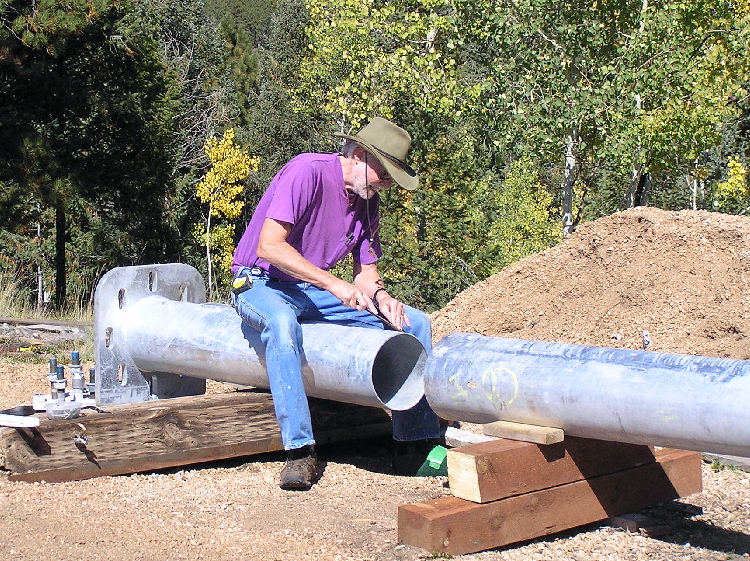

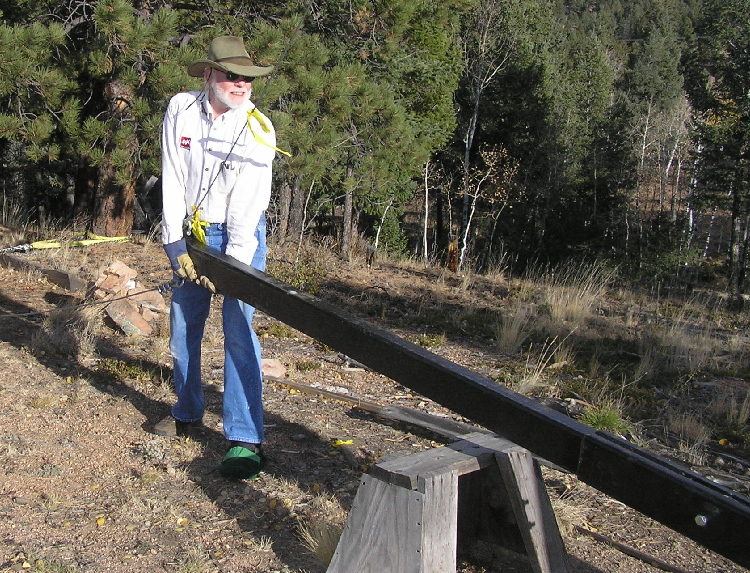

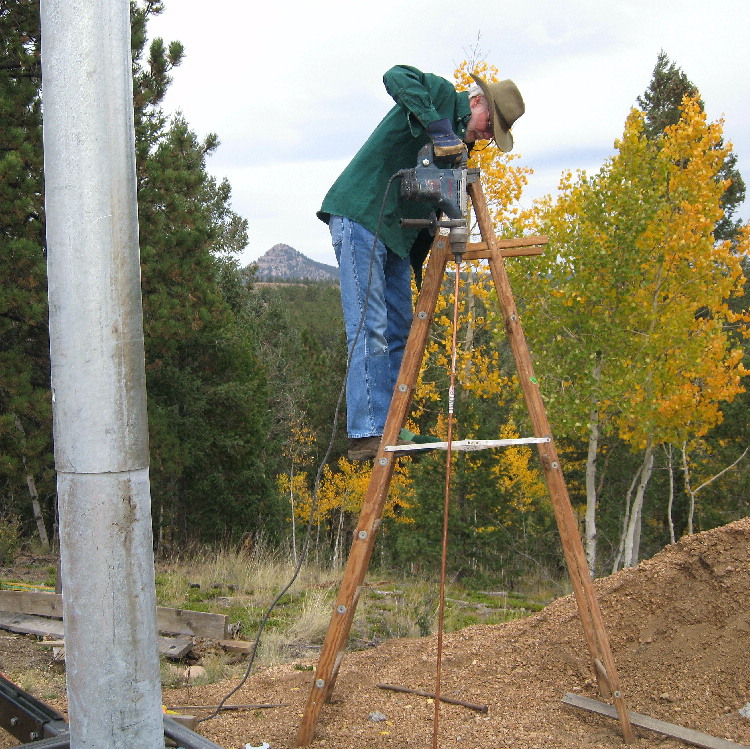

|  De-burring joints with file 9/25/08
|  3 of 5 tower sections in place (sort of), ready for assembly. Oh, and the Aspen are turning. 9/28/08
|

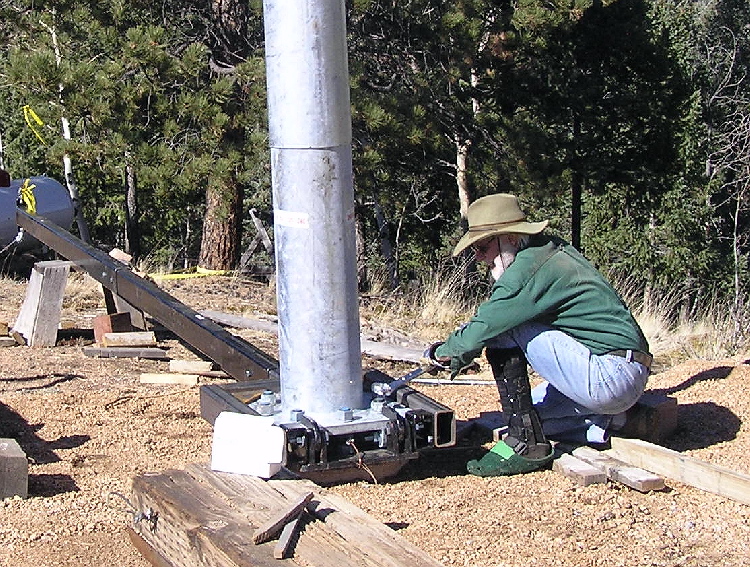

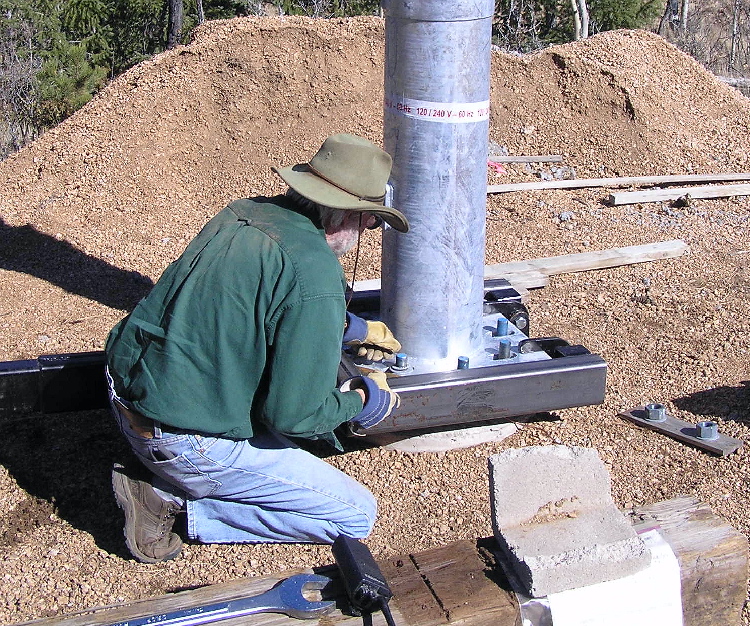

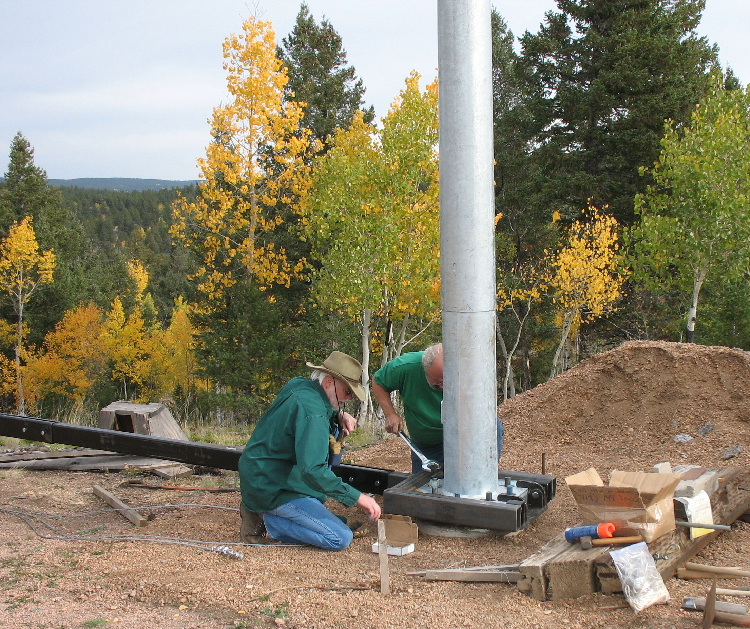

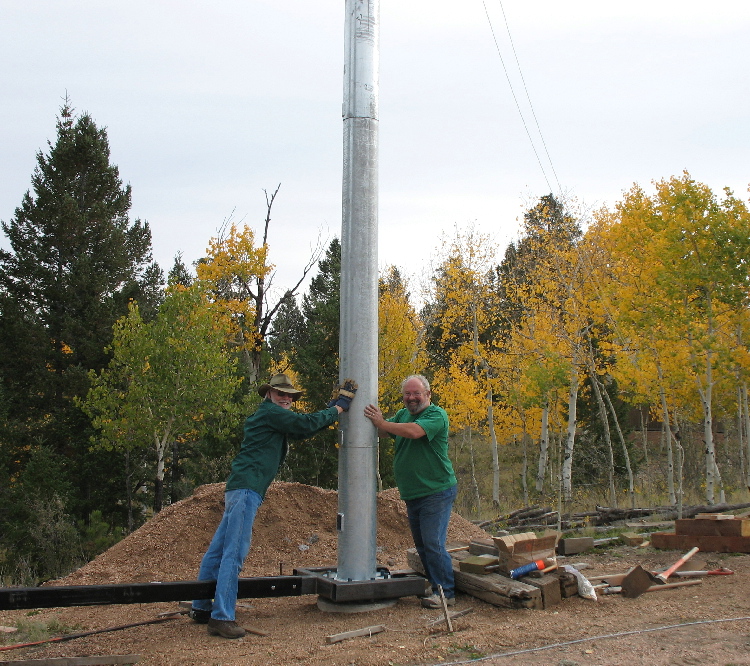

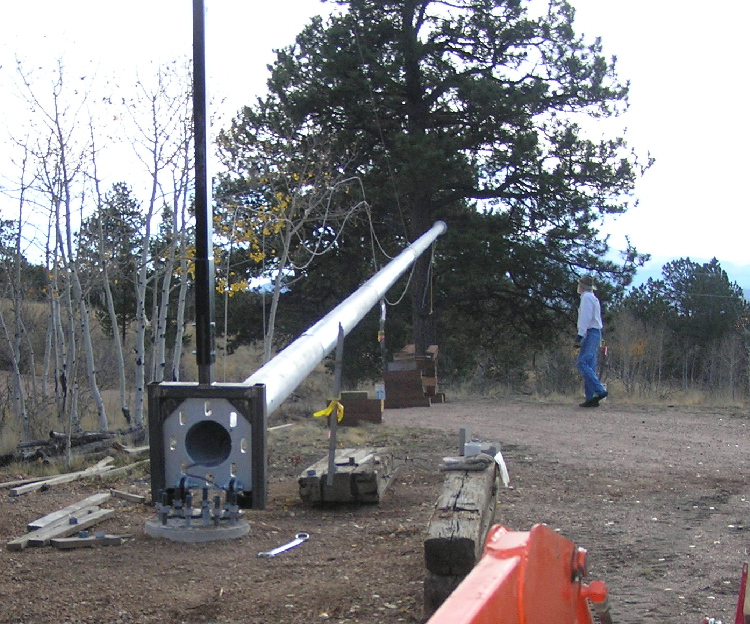

 Tightening hinge base with 1st tower section temporarily
in place 10/2/08

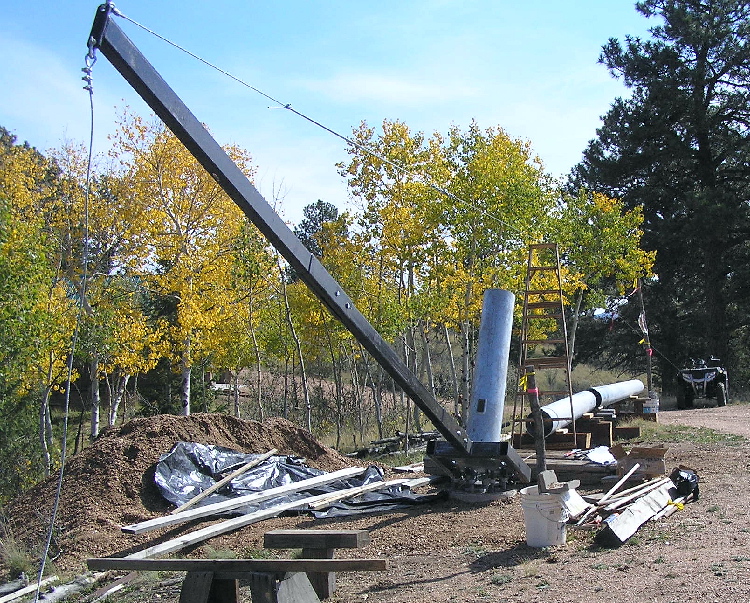

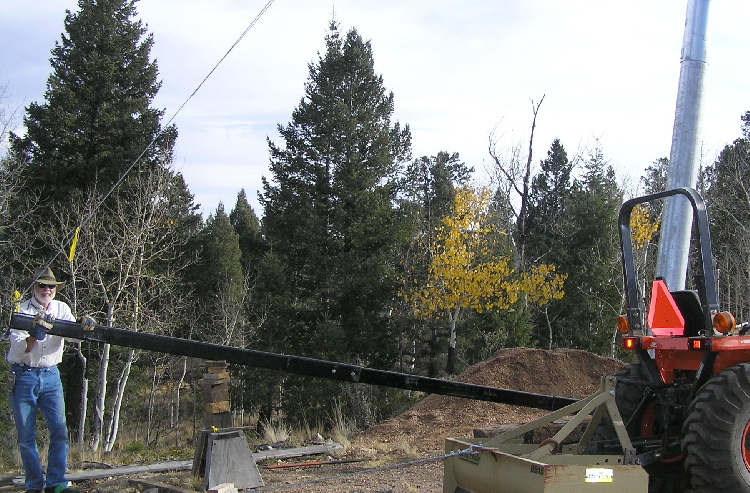

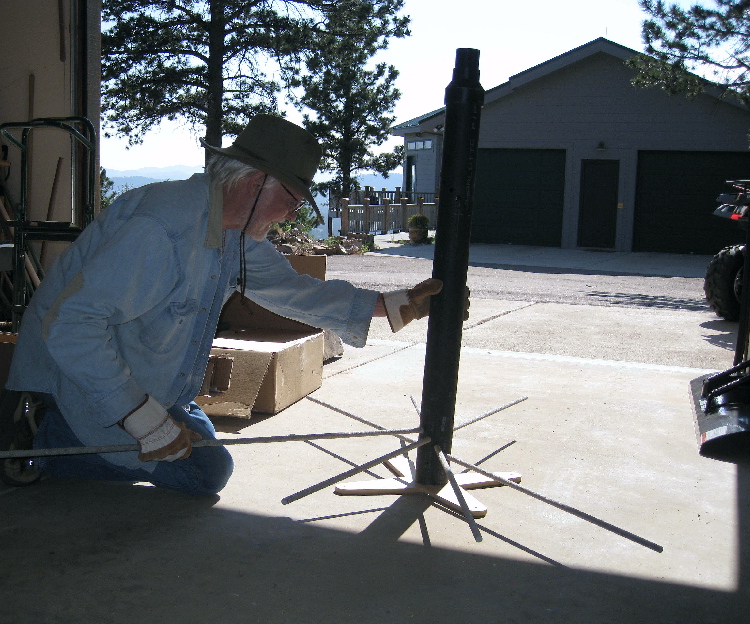

|  Assembling Gin Pole 10/2/08

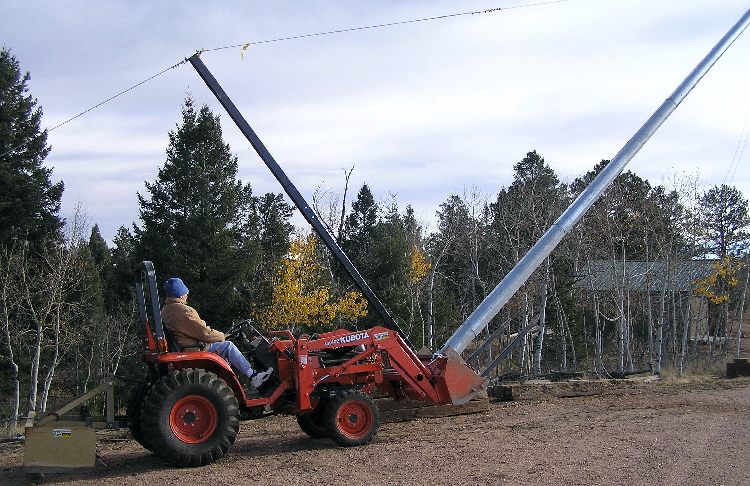

|  Raising Gin Pole to vertical
10/3/03
|
 Dave & Janice Pistole arrive just in time to help assemble
and raise the tower - THANK YOU!
|  Attaching snatch block to truck "anchor" 10/4/08
|  Janice & Dave prepare to pull electric cable to top
|
 Checking lift cable

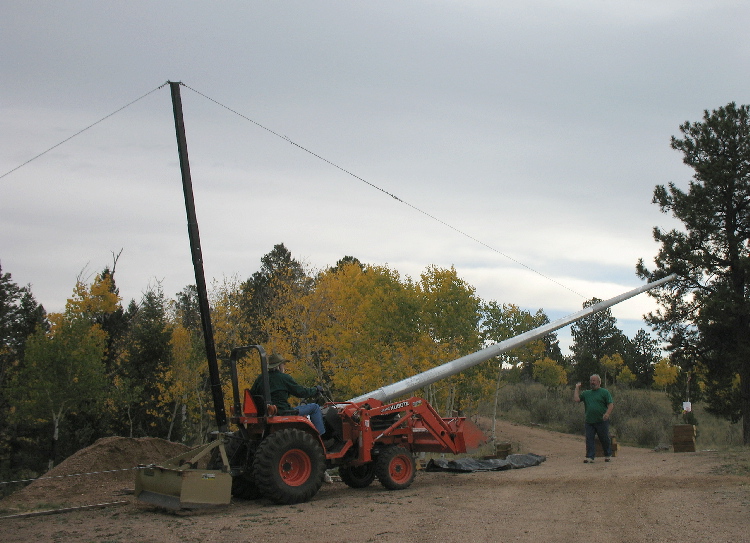

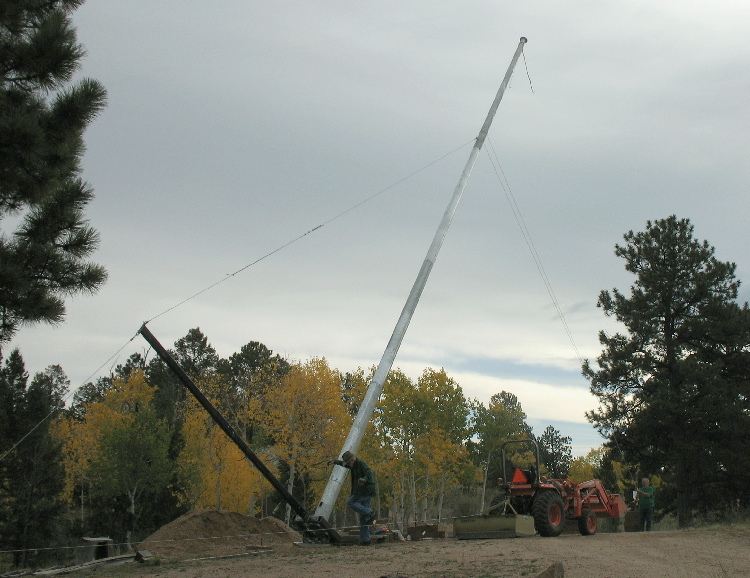

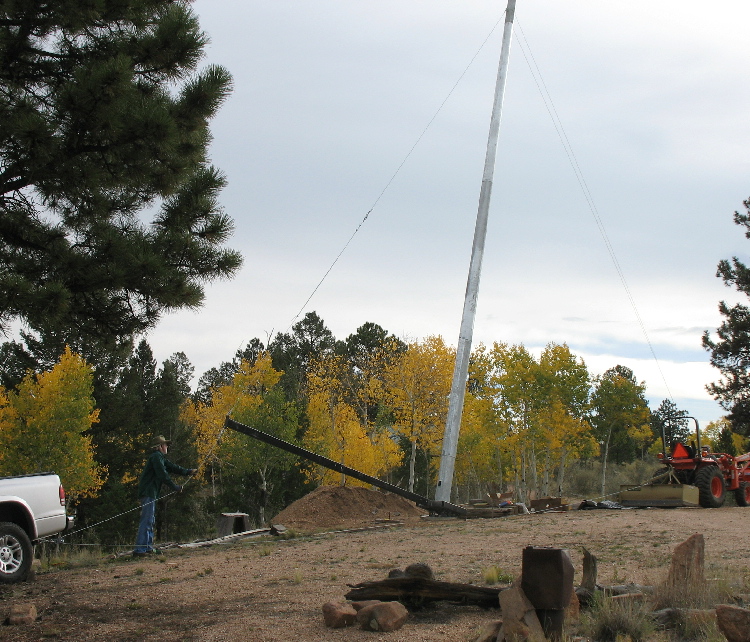

|  Tower starts up

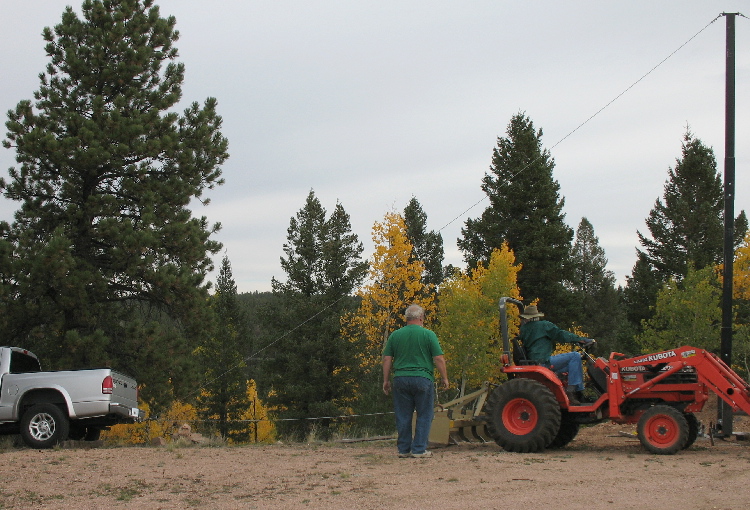

|  Michal's view of lift. She held brakes on "anchor truck"
|
 Checking bolt allignment

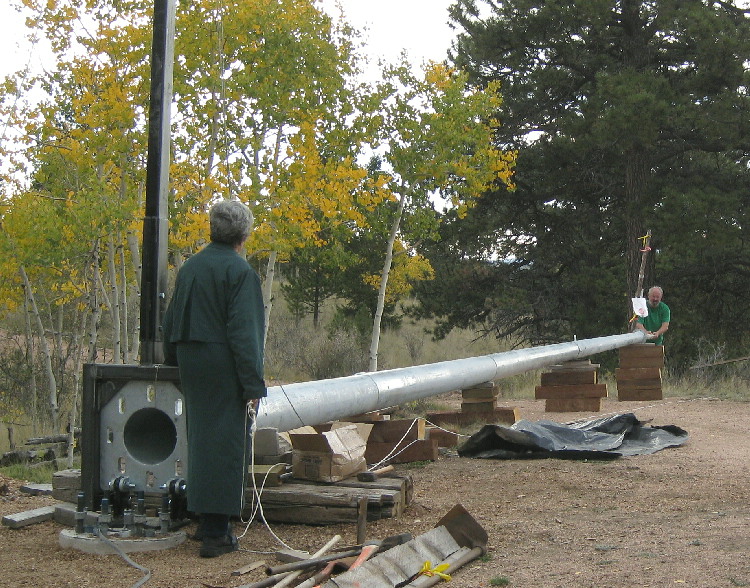

|  Pulling the last few feet by hand
|  We did it - well, with the help of Janice and Michal!
|
 Tighten those nuts!
|  Voltair tower is up - waiting for arrival of turbine
|  Driving 2nd of 2 grounding rods (a grounding coil is also
in base of foundation)
|

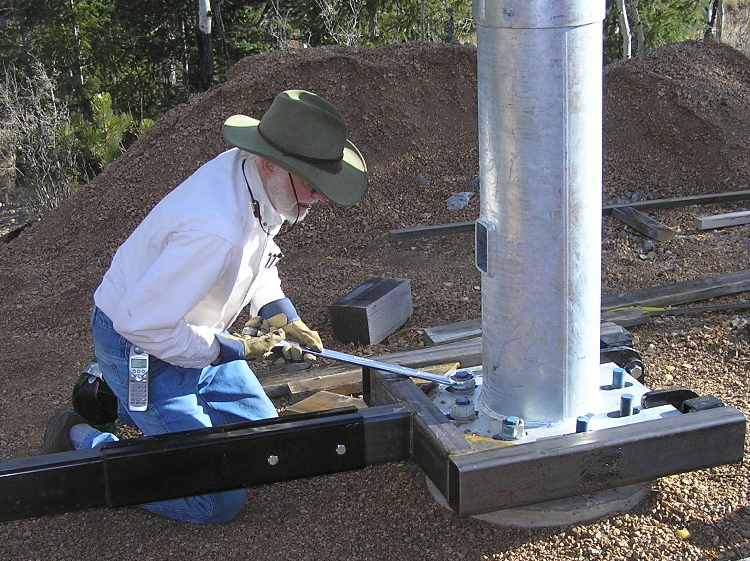

 Removing nuts so tower may be lowered to attach wind turbine 10/21/08

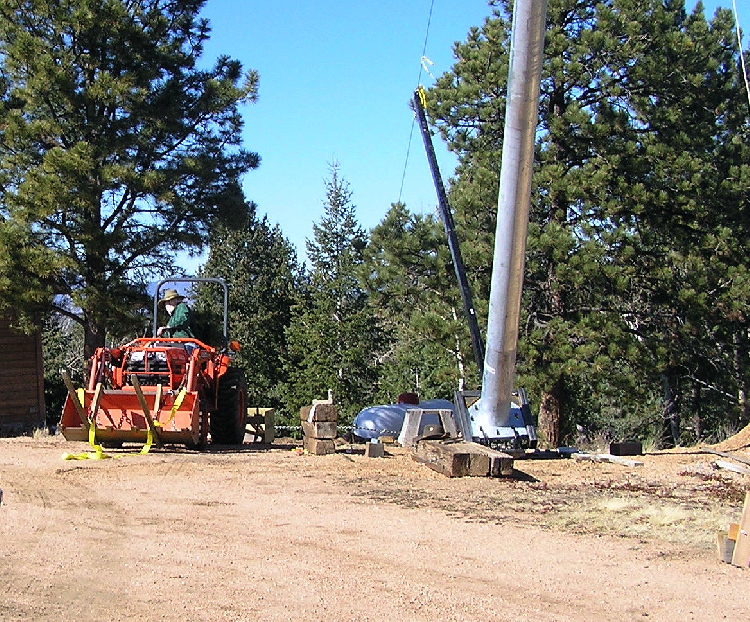

|  Michal ready to start backing to lower tower after tower is tipped by hand
|  Lifting gin pole to tilt tower. Lowering cable attached to
tractor
|
 Almost to tip point. 1 more lift and strain should be on tractor cable
|  Michal controls decent on
way down
|  Almost down on blocks
|
 Down, braced and ready for turbine arrival

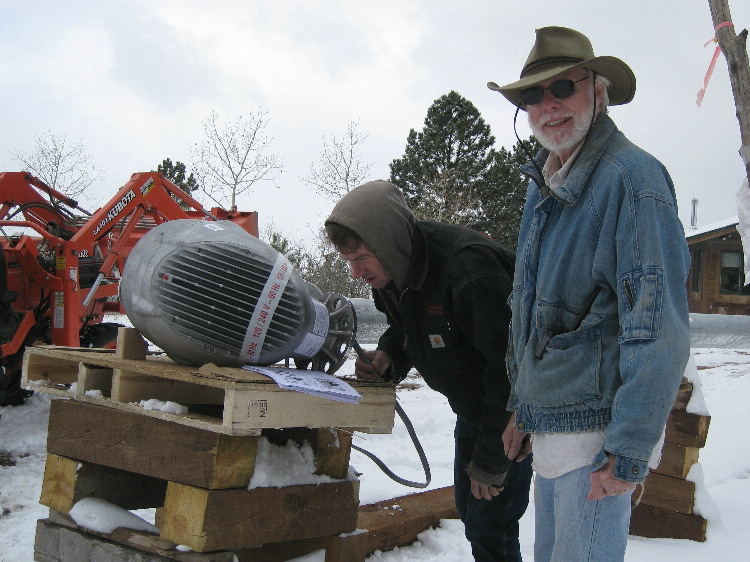

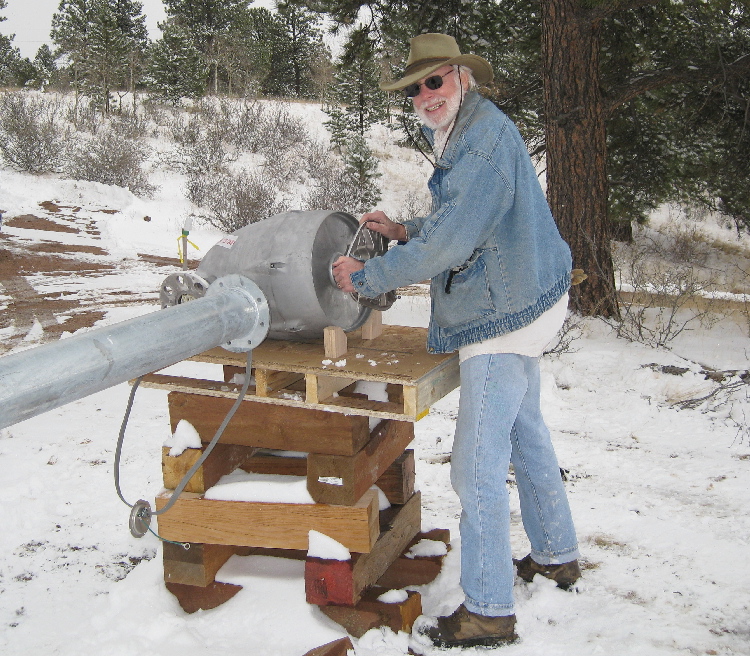

|  Voltair arrives! (Nice of it to snow today, eh?) 10/22/08

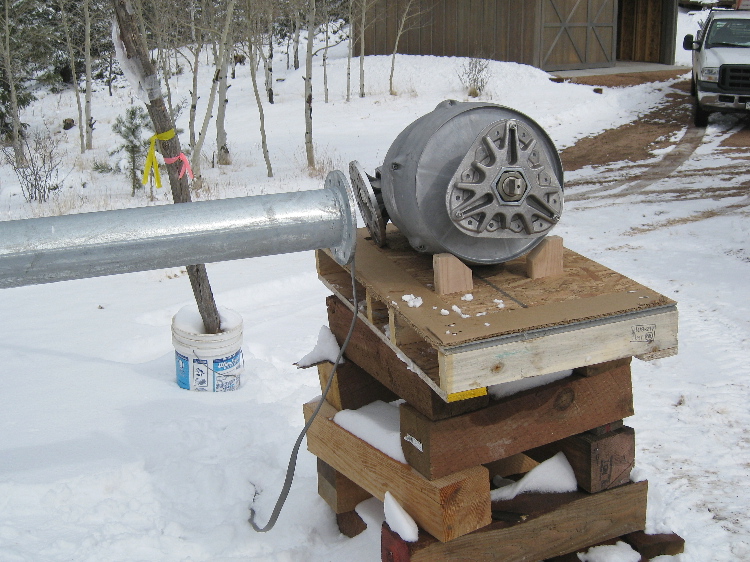

|  Is that all there is? (Well, plus the blades.)
|
 Ready to wire, test & bolt to tower
|  Russ connects cable. Even checks directions!
|  Successful "power on" test!
|
 Time to quit for the day. 22 degrees and snow.

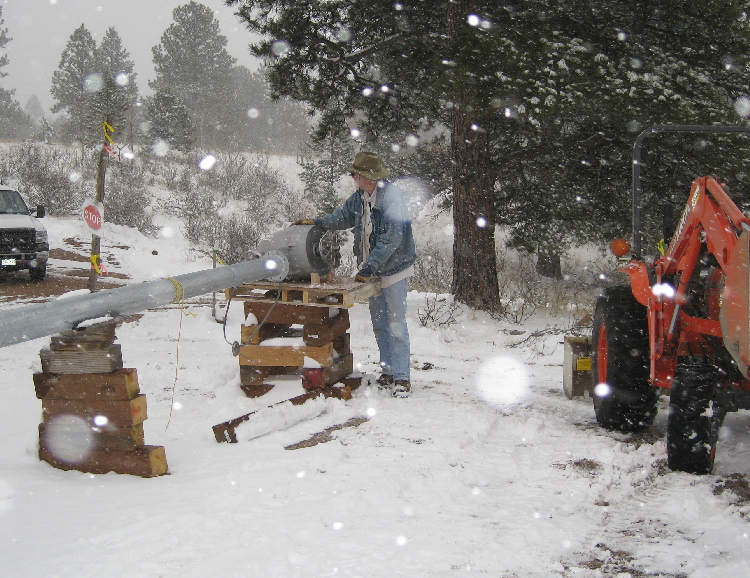

|  Torque those bolts 10/23/08 (Nice left boot . . .)

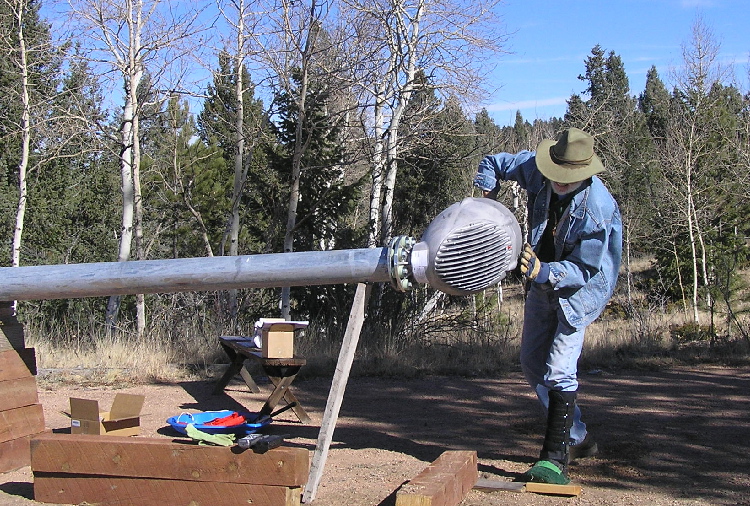

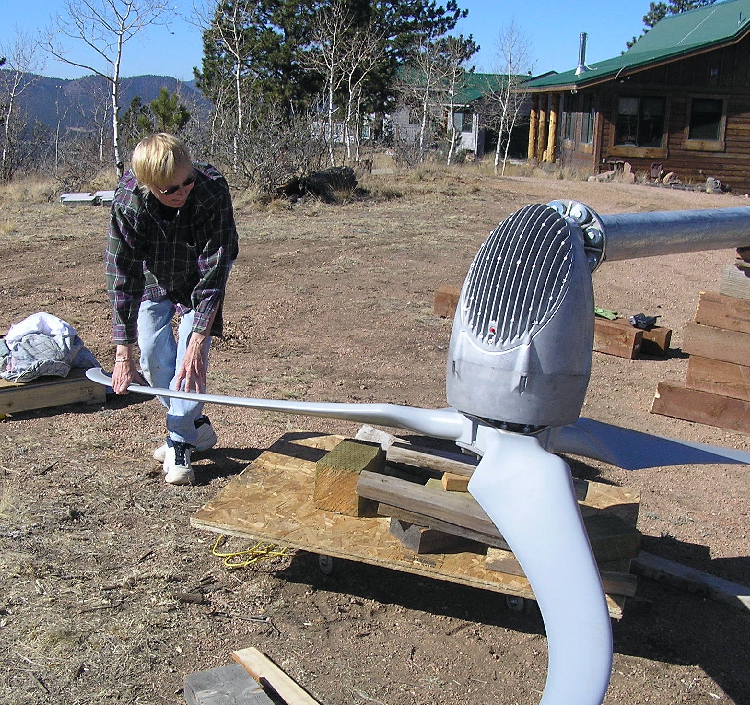

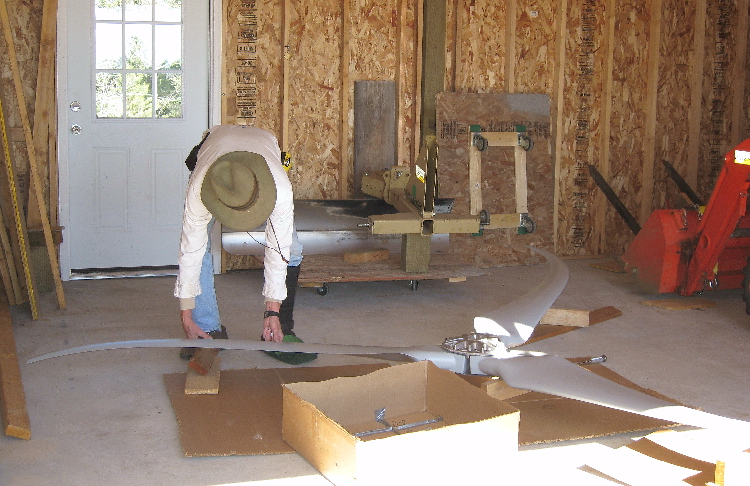

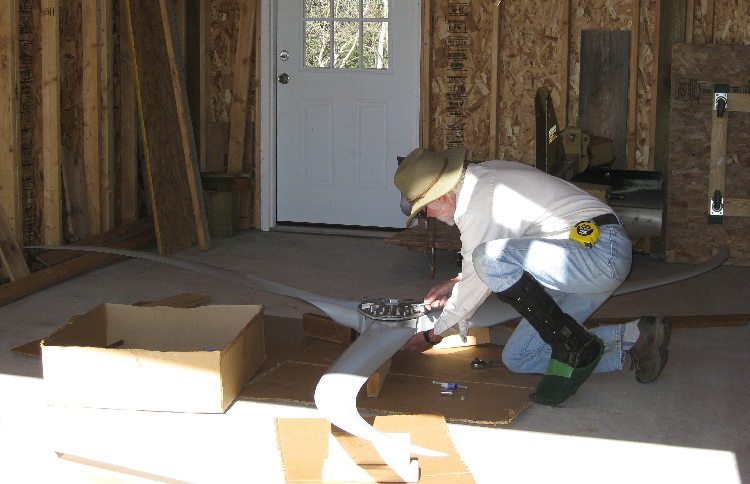

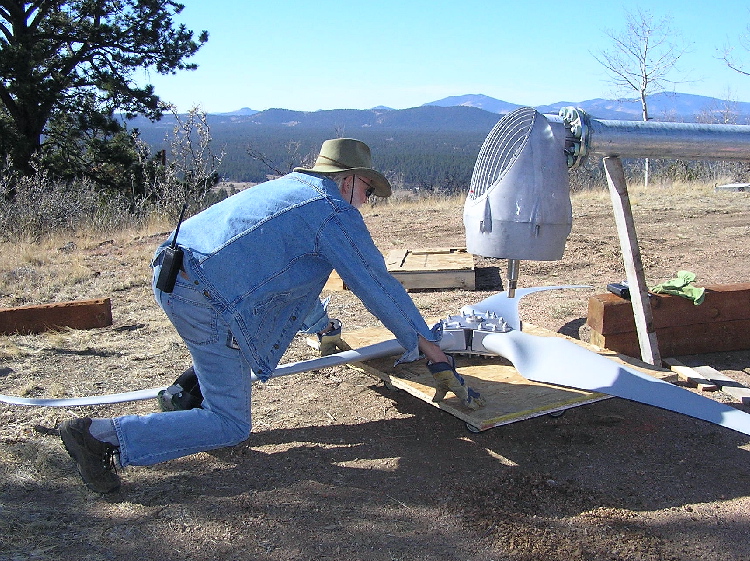

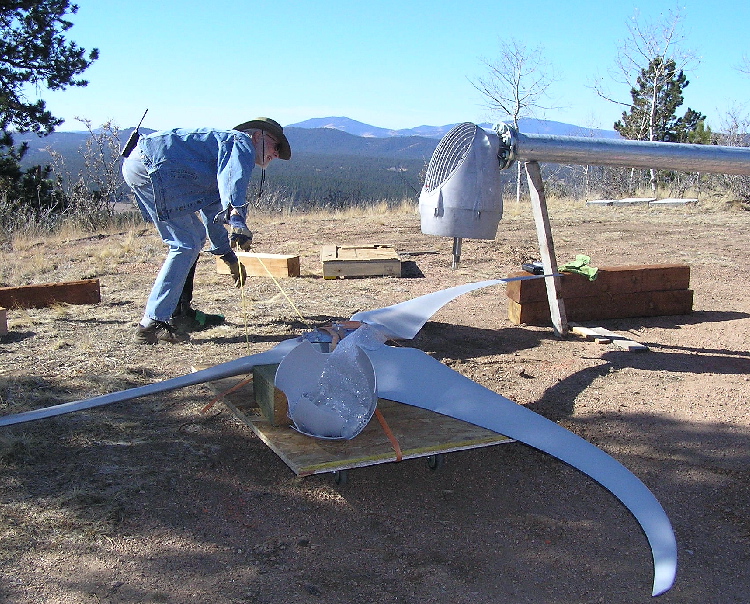

|  Assembling wind blades to hub 10/24/08
|
 Torque 'em!
|  Filling last of trench after Russ finished electrical 10/26/08

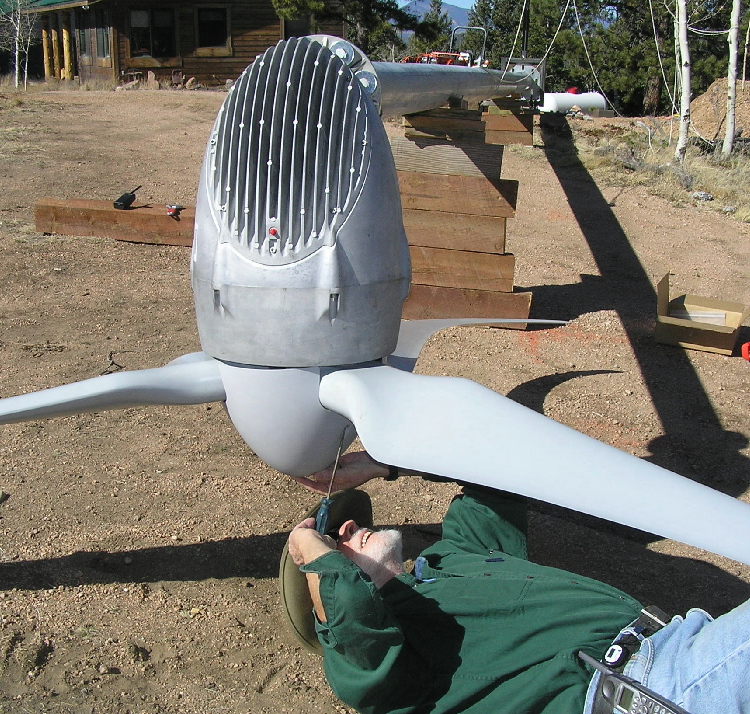

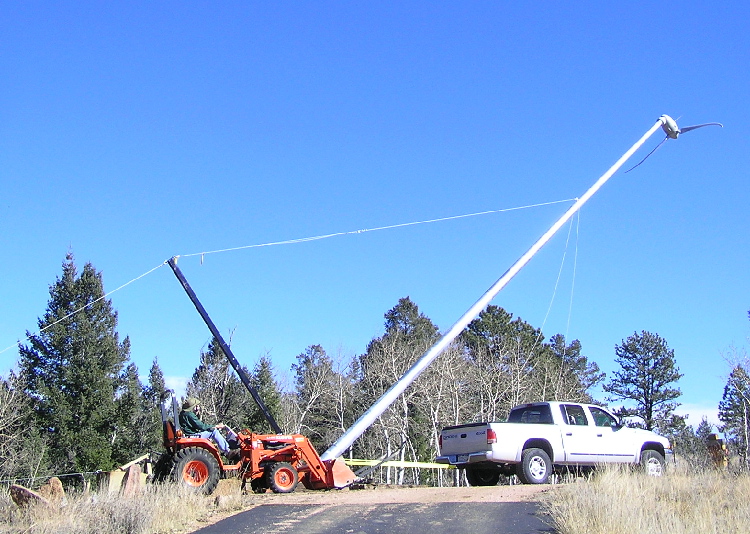

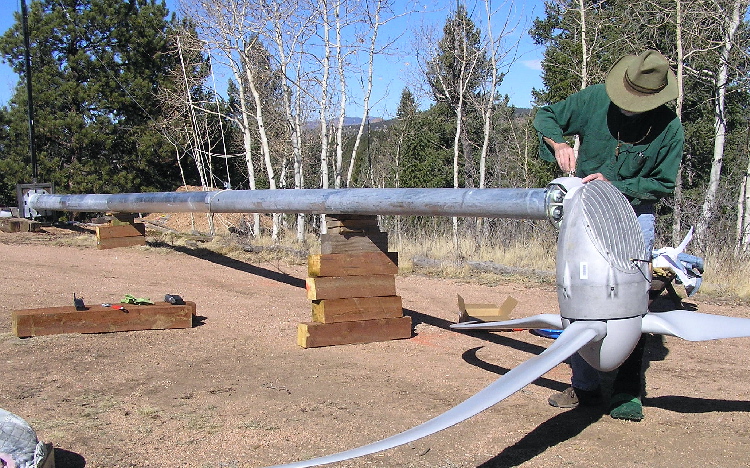

|  Rotate turbine so can attach blade assembly
10/27/08
|
 Blade assembly into position
|
Align with shaft
|  Spin blades tight onto shaft
|
 Attach nose cone
|  And yaw shield
|  Required both tractor and truck to start tower up
|
 Almost up-tractor only now
|  Up! Secure those nuts!
|  Tighten 'em
|
 Just need final inspection and 2-way meter install
|

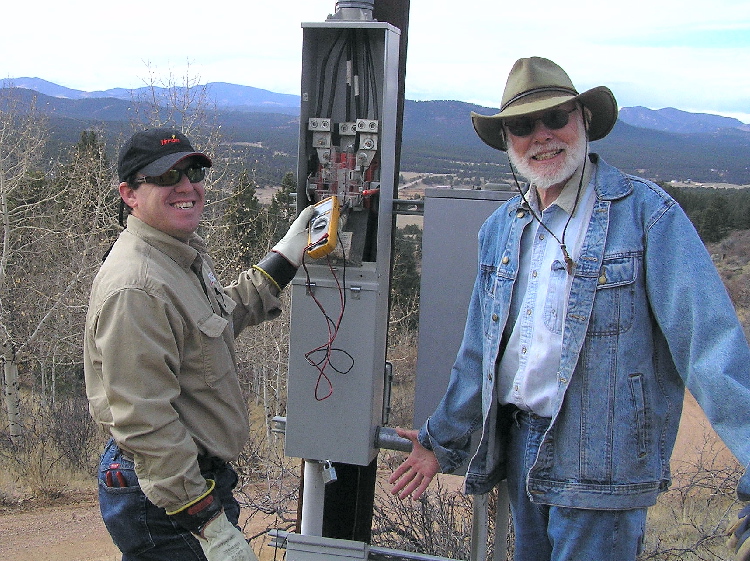

 Building inspector Robert-final sign off on project! 10/28/08
|

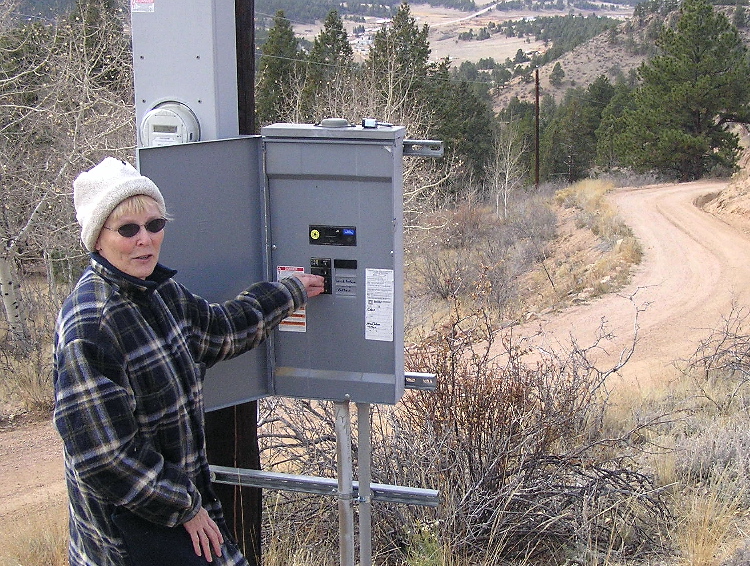

 Carl from electric Co. (IREA) advises WE PASSED the lock- out test! 11/4/08
|
 Michal throws the switch -

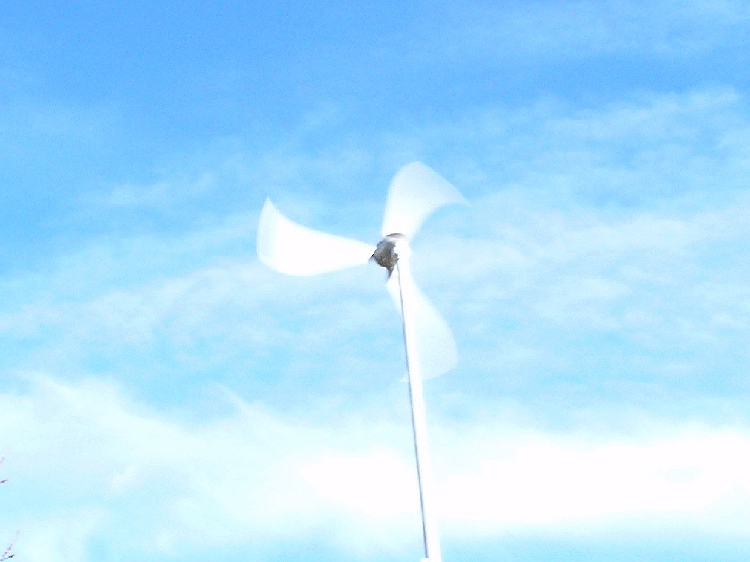

|  - and Voltair is generating
| The idea was 1st discussed in March, '08. We began generating some of our own electricity 11:53 am, 11/4/08!
Thanks to all who helped.
|
